Blocks & boundaries

Published 10 July 2026Updated 18 Sept 20265 min read

Easements on a block: what they are, how to find them, and building rules

An easement is a right registered on the land's title that lets someone else, such as a council, a water authority, a power distributor or a neighbour, use part of the block for drainage, sewerage, water, electricity or access. Building over or near an easement can require the holder's consent or another authority approval, depending on the easement and infrastructure involved, and it can reduce the area available for building even where setback rules would otherwise allow development.


Published 10 July 2026 · Updated 18 Sept 2026

One-off NSW title search
from $19.49
Sold through authorised brokers, not the registry itself
Build-over-easement fee, Cardinia Shire VIC
$338.70
2026-27 application fee, not refunded if refused
QLD referral assessment window
20 days
Business days for the referral service provider to assess
Largest sewer Sydney Water considers building over
≤300 mm
Reticulation sewers only; pressure pipes excluded

Section 01 · The basics

What is an easement on a property?

An easement is a legal right over part of a lot, held by someone other than the owner and registered on the title, for a stated purpose. Cardinia Shire Council's definition: an area of land or part of a lot registered on your property title that gives Council, or another service authority, access to your property1.

The land stays with the owner. Ausgrid states, for electricity easements, that ownership of the land remains with the property2. The easement holder instead gains specified rights over that part of the land, and a registered easement generally continues to apply when the property changes ownership.

Many easements on newly subdivided blocks are created as part of the subdivision process. The plan of subdivision is the surveyed plan registered with the state's land registry that creates the new lots. In NSW that plan is called a deposited plan, and the easements, restrictions and covenants it creates are listed in a section 88B instrument: a schedule lodged with the plan under the Conveyancing Act 1919 that brings those rights into existence when the plan is registered3. NSW Land Registry Services describes the search product in the same terms: instrument 88B shows "any easements or restrictions on a title"4.

Section 02 · The types

Common types of easements and who holds them

Common easements include those for access, drainage, sewerage and the supply of water, gas or electricity. Queensland Government guidance lists common easement purposes: easements including access, drainage, sewerage, and the supply of water or gas5. The easement holder varies by type and determines which registered terms or published policies apply to work affecting the easement. The table below shows four common easement types and examples of the relevant holder's published policy.

An easement's exact terms are in its registered instrument: the restriction column quotes three named holders' published policies, not a universal rule.
Common easement types, holders and building restrictions
Easement typeWho usually holds itTypical restriction (named policy)
Drainage / stormwaterLocal councilCouncil consent to build over; Cardinia Shire (VIC) refuses dwellings and habitable buildings, allows fences and paths with conditions
Sewerage / water supplyWater authority (Sydney Water, Urban Utilities, VIC water corporations)Authority approval before building or excavating near assets; Sydney Water (NSW) does not allow building over pressure pipes
ElectricityDistributor (e.g. Ausgrid in NSW)Houses, sheds, garages and "other large structures" not allowed; written approval required before any work
Access / right of carriagewayA neighbouring lot it servesTerms set by the registered instrument; the holder is the owner of the benefited lot

Source · Cardinia Shire Council build-over page (as archived 16 April 2026); Sydney Water technical guidelines (October 2025); Ausgrid electricity easements page; Queensland Government easements guidance. Retrieved 10 July 2026.

Section 03 · The envelope

How easements affect a block's buildable area

An easement can reduce the part of a block available for building, separately from any setback requirements. A setback can scale with wall height or flex with a council's discretion; a registered easement does neither. Where the easement is wider than the setback on the same boundary, the easement may set a more restrictive building line. A structure the setback rules would otherwise allow then needs the holder's consent, or a redesign.

Worked example: The illustrative lot below is 12.8 m × 30 m (384 m²) with a 2.5 m drainage-and-sewerage easement along the rear boundary; easement widths vary between plans. Queensland's rear clearance for a low wall is 1.5 m under QDC MP 1.1 Table A2(a)6, so on this lot the easement, not the siting code, creates the more restrictive building line: the rear building line sits 2.5 m in, 1.0 m beyond the 1.5 m clearance (derived).

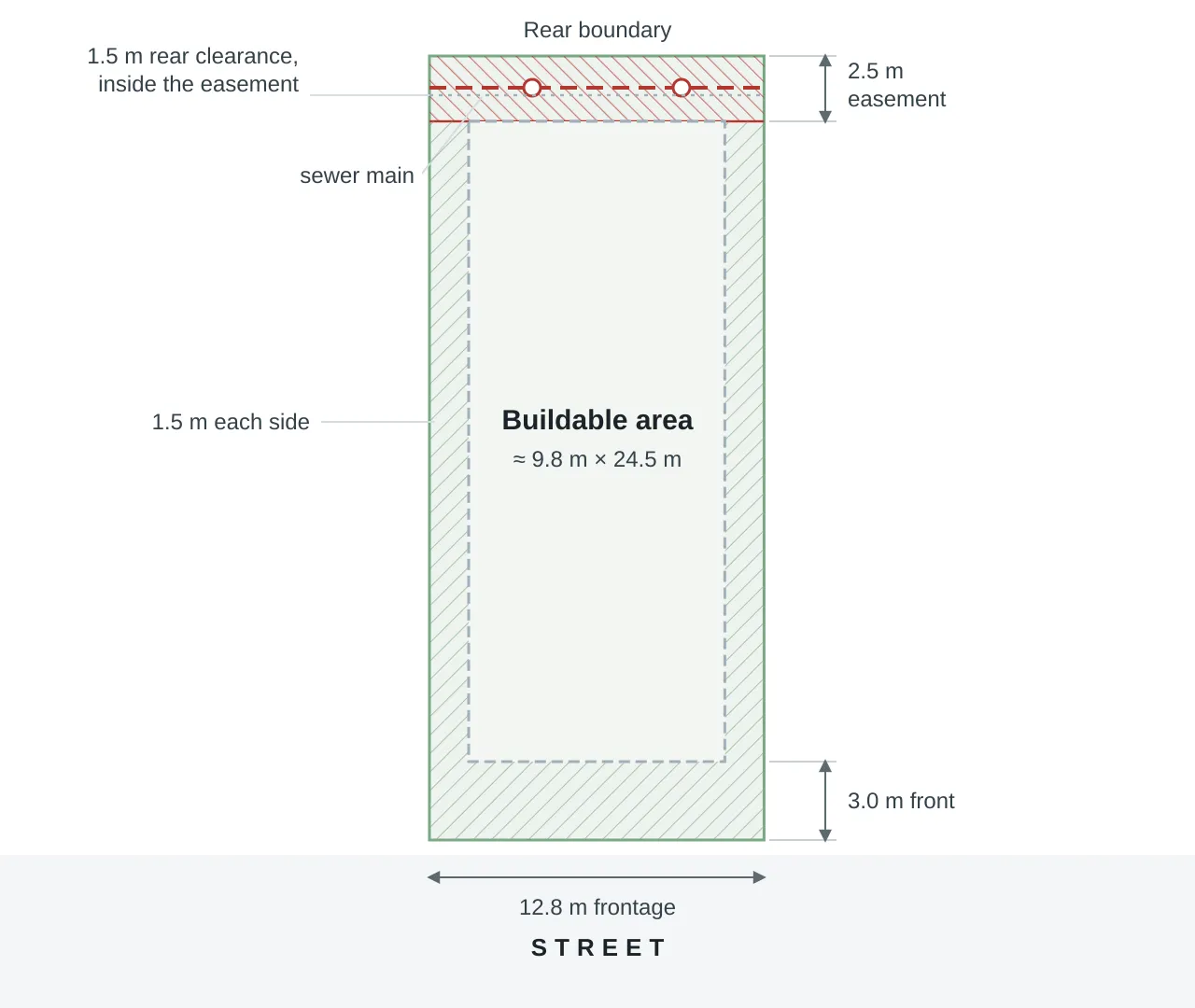

Buildable area on an example Queensland lot with a 2.5 m rear drainage easement

Plan view of a 12.8 m by 30 m lot: hatched 3.0 m front and 1.5 m side setbacks, a 2.5 m rear drainage easement containing a sewer main, and a 9.8 m by 24.5 m buildable area that stops at the easement edge
Illustrative worked example: a 384 m² lot (12.8 m × 30 m) under QDC MP 1.1 siting values (front 3.0 m to an access street; sides and rear 1.5 m for low walls, the general Table A2(a) value; Table A2 sets reduced side clearances for frontages of 15 m or less). The 2.5 m easement width is illustrative; actual widths are set by the registered plan.

Section 04 · The title

How to find the easements on a block

Easements are recorded in the title and registered plan, with the exact documents varying by state. A NSW title search shows any mortgages, caveats, deeds or easements on the property4; the details including the easement's location, purpose and benefiting party, may be recorded on the plan and, in NSW, the section 88B instrument described above. Public map layers are not a substitute for the registered documents: the metadata for Victoria's statewide easement layer states that only a subset of easements have been captured7.

On a specific block, the documents are checked in this order:

  1. Order a title search. It lists the registered interests over the lot, including easements.
  2. Order the registered plan. NSW: the deposited plan plus the s 88B instrument; VIC: the Copy of Plan; QLD: the survey plan image. The plan and associated instruments can provide details not shown on the title, including an easement's width, location, purpose and benefiting party.
  3. Read the easement's terms. The registered instrument sets the rights attached to the easement and any conditions affecting its use.
  4. A Before You Dig Australia (BYDA) enquiry can separately show nearby underground or overhead services. It locates services in the ground, not registered easements.
Easement search documents and costs by state
StateWhat to orderWhereCost
NSWTitle search, then the deposited plan + s 88B instrumentNSW LRS authorised information brokers (LRS doesn't sell one-off searches directly)$19.49-$98.00 title search; $19.90-$78.00 plan or dealing (registered document) image
VICRegister Search Statement (copy of title) + Copy of Plan: the plan shows "any existing easements over the property"LANDATA (landata.online), within 5 min by emailPaid; fees published by Land Use Victoria, shown at order
QLDCurrent title search + image of survey planTitles Queensland online search$25.71 title; $27.56 plan image
All statesPlans of underground services near the work site (assets, not the registered easement)Before You Dig Australia (byda.com.au)Free

Source · NSW range is NSW LRS's published one-off broker/reseller price list (updated 1 April 2026); 8 of the 13 listed brokers charge between $21.10 and $44.00 for a title search (derived from that list). QLD prices as listed on the Titles Queensland searches page, 10 July 2026; statutory fees, no GST. Retrieved 10 July 2026.

Section 05 · Consent to build

Building over easements in NSW, Victoria and Queensland

NSW, Victoria and Queensland all have approval or consent requirements for some building work over or near easements and service infrastructure, but the mechanism differs by state and asset holder.

StateWho consentsThe mechanismA number to know
NSWSydney Water, for its pipes and easementsApproval before building or digging near assetsStructures considered over reticulation sewers ≤300 mm only
VICThe service authority the easement is vested inReport and consent under reg 130, Building Regulations 2018$338.70 application fee (Cardinia Shire, 2026-27)
QLDEvery registered easement holderConsent required before approval under s 65, Building Act 197520 business days for a referral agency to assess

Source · Summary of the instruments and policies detailed below; the named fee and pipe limits are examples from the cited documents, not statewide schedules.

NSW: Sydney Water approval for building near assets

Sydney Water's rule is that approval may be required before building or digging near its assets. This includes work affecting pipes, drains, meters and easements8.

Its technical guidelines set different requirements according to the type and size of the asset. Certain structures can be considered under the standard provisions for reticulation sewers with diameters of 300 mm or smaller.9 Larger wastewater assets can require referral or specialised assessment.

Some assets have additional restrictions. Building over pressure pipes, sewer connection points and maintenance structures, as well as certain easements, assets in poor condition and asbestos-cement pipes, is not permitted under the technical guidelines.9

Regulation 130(1) of the Building Regulations 2018 requires the report and consent of the relevant service authority for a building permit application involving construction over an easement vested in that authority.10 The service authority that holds the easement must give its report and consent as part of the building permit application.

The regulation's notes add the water layer. Section 148 of the Water Act 1989 prohibits building a structure or placing fill, without the water corporation's consent, over land where an easement exists in favour of a water supply authority or for water supply, sewerage or drainage purposes10. Council report-and-consent fees are set council by council. Cardinia Shire, the Victorian example used through this article, charges $338.70 (2026-27) per application, not refunded if the application is not approved1.

Under section 65 of the Building Act 1975, if land is subject to a registered easement, the assessment manager, which may be a council or private certifier assessing the building application, cannot approve the application unless each registered easement holder has consented to the building work11.

Work over or near sewers, water mains and stormwater drains is assessed against QDC MP 1.412. A proposal outside MP 1.4's acceptable solutions goes to the service provider as a referral agency, whose assessment forms part of the building application. The referral agency has 20 business days to assess the application13. Urban Utilities' acceptable solutions apply to Class 1 and 10 buildings or structures, including houses and non-habitable structures such as sheds and carports, within three metres of a gravity sewer less than 300 mm in diameter14.

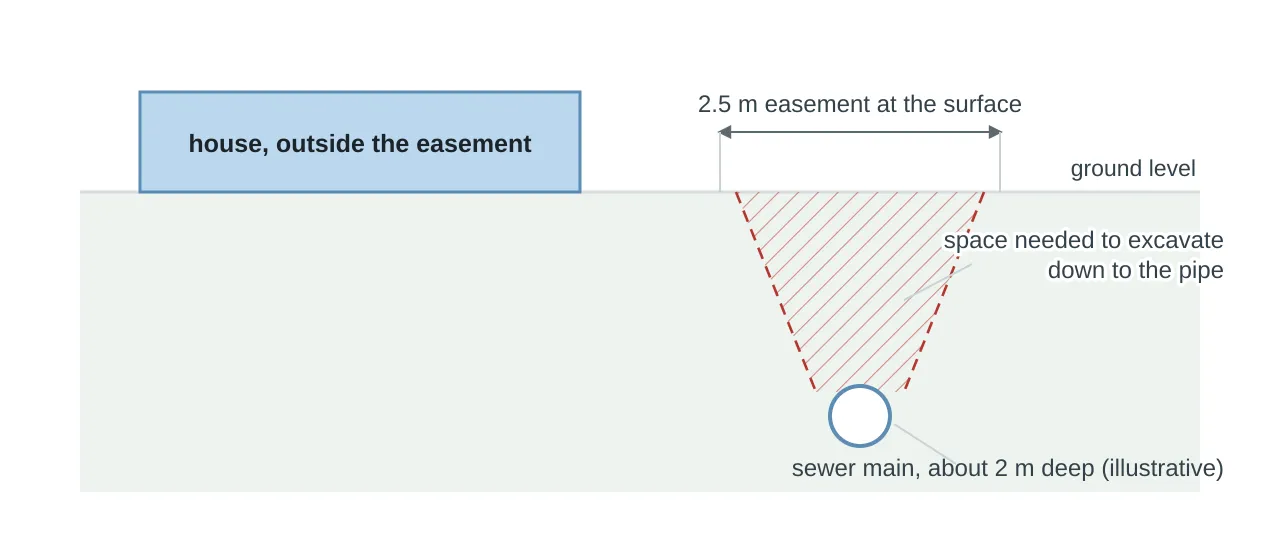

Maintenance access above a sewer main inside a drainage-and-sewerage easement

Cross-section: a house sits outside a 2.5 m easement; under the easement a sewer main lies about 2 m deep, with dashed lines marking the wedge of ground needed to excavate down to it
Illustrative cross-section: the pipe depth shown (about 2 m) and the geometry are illustrative, not taken from a named plan.

Section 06 · building limits

What can be built over an easement?

What can be built over an easement depends on the easement holder and the terms that apply to it. Across the three authorities reviewed here, Cardinia Shire in Victoria, and Sydney Water and Ausgrid in NSW, published policies generally distinguish between landscaping, lighter or removable structures, and permanent buildings. The requirements are specific to each authority and should not be treated as national rules.

What different authorities allow over or near easements
ProposalLikely answerNamed policy
Grass, turf, mulchNo application neededCardinia Shire (VIC), build-over-easement rules
Fencing (incl. pool fencing), concrete paths, eaves, cut-and-fillLikely approved, with conditionsCardinia Shire
Concreting a driveway near water assetsApproval required firstSydney Water, building over or next to assets
Garden shed, pergola, deck, water tank, detached steel-frame garageLikely approved subject to a s 173 agreement on the titleCardinia Shire
Lightweight structures over a reticulation sewer ≤300 mmConsidered, but they cannot be permanently enclosedSydney Water technical guidelines (October 2025)
Dwelling or habitable building, pool, spa, sauna, permanent brick garageRefusedCardinia Shire
Anything over pressure pipes or sewers >750 mmNot allowedSydney Water technical guidelines (October 2025)
Houses, sheds, garages on an electricity easementNot allowed; written approval needed before any workAusgrid, electricity easements

Source · Cardinia's lists apply to easements and land within 1 m of a council stormwater drainage asset; a s 173 agreement is an agreement with the council recorded on the title that binds future owners. Cardinia page as archived 16 April 2026; other policies retrieved 10 July 2026.

Section 07

Frequently asked questions

What is an easement in simple terms?

A right, registered on the land's title, for someone else to use part of a block for a stated purpose: commonly drainage, sewerage, water, electricity or access. The land stays with the owner, but the holder can enter and use that strip, and building over it generally needs their consent.

How do I find out if my block has an easement?

A title search and registered plan show the registered easements affecting a block. In NSW, this can include a title search plus a section 88B instrument via an NSW LRS-authorised broker; one-off title searches run from $19.49-$98.00 on NSW LRS's broker price list (updated 1 April 2026). In Victoria, the relevant documents include a Register Search Statement and Copy of Plan via LANDATA. In Queensland, a title search costs $25.71 and a survey plan image costs $27.56 via Titles Queensland, as listed on 10 July 2026.

Can I build a shed or garage over an easement?

Sometimes, with consent. Cardinia Shire (VIC) lists garden sheds and detached steel-frame garages as structures that may be approved over a drainage easement, subject to a section 173 agreement recorded on the title. Permanent brick or weatherboard garages and sheds are listed as not likely to be approved. If the easement belongs to a water authority, that authority's requirements also apply.

Can I put a fence, garden or driveway on an easement?

Requirements vary by easement holder and structure. Cardinia Shire needs no application for grass, turf or mulch, and lists fencing and concrete paths as likely to be approved with conditions. Near water assets, separate approval requirements can apply. Sydney Water, for example, requires approval for some work involving driveways near its pipes.

Does Before You Dig Australia show easements?

No. BYDA is free and provides asset owners' plans showing underground or overhead infrastructure near a work site, but it shows where pipes and cables physically sit, not registered property rights. An easement can exist with no pipe in the ground yet, and a pipe can exist with no easement. Registered easement details are found in the relevant title, plan and associated instruments.

Who owns the land under an easement?

The property owner does. The easement does not transfer ownership of the land to the easement holder. Instead, the holder gains specified rights to use the affected part of the property for the easement's stated purpose. A registered easement generally continues to apply when the property changes ownership.

Check your own block

BuildStreet's lot report includes an easement-layer check where public data exists (for example, sewer-proximity flags from council layers) and reports "unknown: check your title" where it doesn't, because many easements appear only on the registered plan or title and in no public web layer. Type your address, see what the public record shows, and what it can't.
