Market Research

Updated 5 min read

Where is residential land still available in Australia?

Australian land estate with vacant lots and new homes

Updated

Australia has large volumes of land zoned for housing across every state, but much of it is not yet ready to build on. In New South Wales, for example, 59 per cent of zoned residential land in the Sydney Mega-Region is constrained, while in Queensland more than half of greenfield land is still waiting on infrastructure. This gap between zoned land and development-ready land is a key factor limiting how quickly new homes can be delivered.

Homes target by 2029
1.2M
National Housing Accord
Sydney greenfield supply
3.2 yrs
Most constrained market nationally
Sydney region land constrained
59%
More than half of its zoned land can't be built on yet
Greater Bunbury supply (WA)
55 yrs
Longest reported supply in Australia
Is it cheaper to build or buy in Australia?Is it cheaper to build or buy in Australia?Building a new home is cheaper than buying an established one in four of Australia’s eight capital cities: Perth, Adelaide, Sydney and Brisbane. In Darwin, Hobart, Melbourne and Canberra, buying an…How much does it cost to build a house in Australia? (2026)How much does it cost to build a house in Australia? (2026)Building a new house in Australia costs $474,939 on average for the structure alone, based on the latest ABS completion data. Add land at the national median lot price of $403,570 and the total comes…

Section 01 · development-ready land

Where is residential land available in Australia by state?

Residential land is available across Australia, but not all zoned land is ready for housing development. Land supply is measured differently across states, and definitions and reporting periods vary.

The figures below provide a state-by-state view of residential land supply, based on the most recent data.

New South Wales

NSW has completed 55,625 new homes since July 2024, but the pipeline ahead is tight. Within the Sydney Mega-Region, 59 per cent of zoned residential land is constrained and cannot deliver housing as planned. Only 3.2 years of greenfield supply remain at current rates, and 89 per cent of lots expected over the next eight years are not development-ready. The main constraints are infrastructure funding gaps and biodiversity requirements.

In the Lower Hunter alone, 22,830 homes are delayed due to unfunded road upgrades1. UDIA NSW estimates a further $237 million in government funding could unlock additional sites and bring forward around 14,000 more homes.

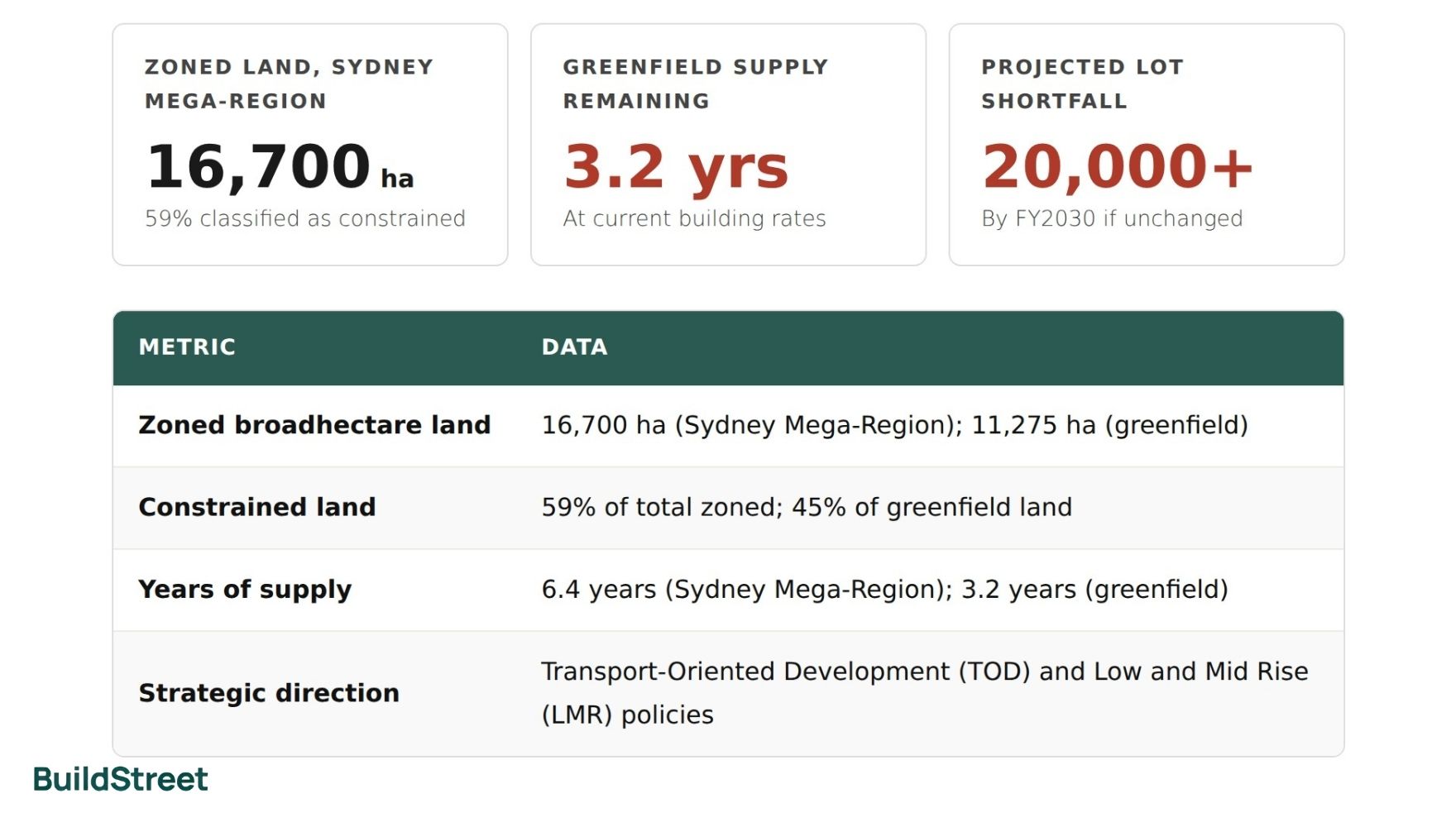

Zoned land, Sydney Mega-Region
16,700 ha
59% classified as constrained
Greenfield supply remaining
3.2 yrs
At current building rates
Projected lot shortfall
20,000+
By FY2030 if unchanged
MetricData
Zoned broadhectare land16,700 ha (Sydney Mega-Region); 11,275 ha (greenfield)
Constrained land59% of total zoned; 45% of greenfield land
Years of supply6.4 years (Sydney Mega-Region); 3.2 years (greenfield)
Strategic directionTransport-Oriented Development (TOD) and Low and Mid Rise (LMR) policies

Victoria

Victoria has a substantial supply of land identified for future housing, particularly in Melbourne's outer growth areas. The state continues to develop new housing estates on the outskirts of Melbourne, alongside apartments and townhouses in established suburbs.

As of January 2025, Melbourne's growth corridors held over 294,000 lots across zoned and unzoned englobo land, with 39,812 actively in subdivision2.

However, fewer greenfield lots received titles in 2024. Only 18,543 greenfield lots were titled in 2024, down from 22,727 the year before2. Melbourne's major redevelopment pipeline in established areas holds 158,533 dwellings at various stages.

\* N/A — Data not available for H1 2024 at the time of reporting.

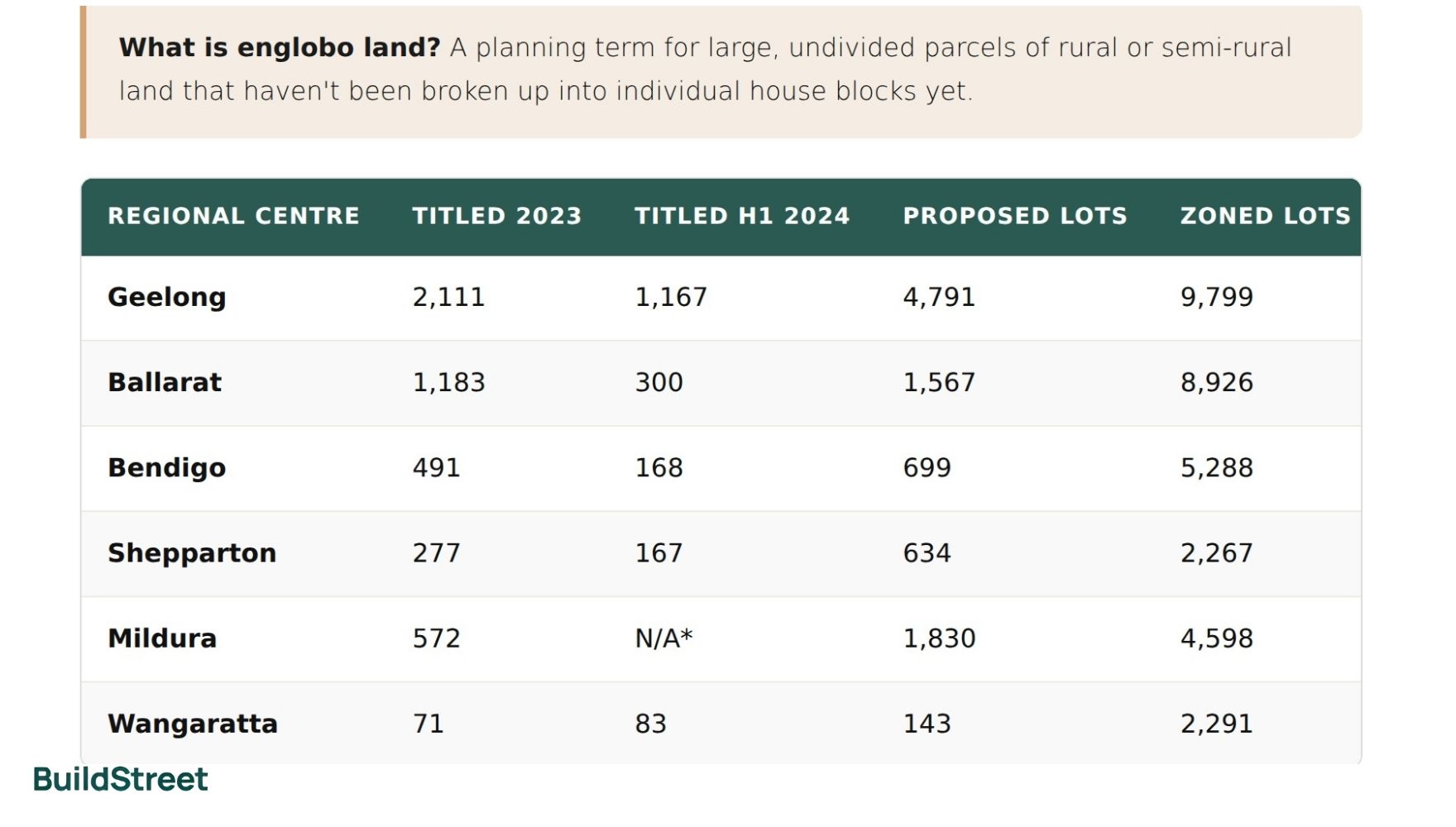

Regional CentreTitled 2023Titled H1 2024Proposed LotsZoned Lots
Geelong2,1111,1674,7919,799
Ballarat1,1833001,5678,926
Bendigo4911686995,288
Shepparton2771676342,267
Mildura572N/A*1,8304,598
Wangaratta71831432,291

Source · Victorian Urban Development Program 2025.

MetricData
Active subdivision pipeline39,812 proposed greenfield lots2
Lots titled in 202418,543 (down from 22,727 in 2023)2
Major redevelopment pipeline (Melbourne)158,533 dwellings at various stages2
Years of supply (regional)Up to 31 years (e.g., Horsham)

Queensland

Queensland has zoned capacity for nearly 580,000 greenfield homes and over 1,000,000 infill homes3. The bottleneck is infrastructure, not zoning. More than half of existing greenfield land is idle, waiting on roads, water and sewerage4.

Economic Development Queensland (EDQ) approved 8,003 dwellings in Priority Development Areas in 2024–25 and committed $100.5 million to unlock more than 3,500 homes5. South East Queensland needs 104,000 more homes by 2029.

MetricData
Zoned broadhectare capacity~580,000 homes (greenfield); ~1,000,000 homes (infill)3
Infrastructure constraintOver half of greenfield land awaits infrastructure4
EDQ approvals (2024–25)8,003 dwellings in Priority Development Areas5
Housing development target70% infill / 30% greenfield (ShapingSEQ 2023)
Years of supplyMinimum 15 years (planned); minimum 4 years (approved)

Western Australia

WA has one of the largest raw land supplies in the country, with roughly 117,770 hectares of zoned land across Perth, Peel and Greater Bunbury, and over 26,000 hectares still undeveloped6.

The state also assesses land according to environmental restrictions, using three categories (A, B and C) to identify areas where development may be limited.

Residential lot approvals increased 38 per cent to nearly 24,000 in the year to June 2025. Infill housing accounted for 39 per cent of new development in 20246, below the state's long-term target.

RegionUrbanised Area (ha)Undeveloped Area (ha)Total Zoned (ha)
Perth Metropolitan78,51019,790698,3006
Peel Region6,5502,58069,1406
Greater Bunbury6,6403,700610,3406
MetricData
Total zoned land117,770 ha across Perth, Peel, and Greater Bunbury6
Undeveloped zoned land26,070 ha6
Residential lot approvals (2024–25)~24,000 (38% increase year-on-year)
Actual infill rate (2024)39% (below long-term strategic targets)6
Years of supplyAbout 26 years (Perth/Peel); 55 years (Greater Bunbury)

South Australia

SA law requires the government to hold at least 15 years of residential land supply before unlocking new greenfield land. Greater Adelaide has around 139,000 allotments zoned for housing, although this does not mean they are all ready for development.

The state is also rolling out the largest land release in state history: 25,000 homes across Dry Creek, Concordia and Hackham. Infill historically dominates, making up 67 per cent of new supply between 2017 and 2021.

MetricData
Zoned allotments~139,000 (Greater Adelaide)
Total lots identified203,759+
New mega land release25,000+ homes (Dry Creek, Concordia, Hackham)
Infill vs greenfield67% infill / 33% greenfield (2017–2021)
Years of supply15+ years (statutory minimum maintained)

Tasmania

In Tasmania, Greater Hobart has capacity for more than 34,000 homes within its urban growth boundary, enough to meet a projected demand of around 30,000 homes over 30 years7.

However, some land identified for housing may be difficult to develop. Areas such as Scottsdale have an estimated 35 to 40 years of residential land supply, but steep terrain and difficulties connecting to sewerage can limit how much of that land is suitable for development.

MetricData
Identified dwelling capacity34,000+ within Greater Hobart's urban growth boundary7
Target supply split70% infill / 30% greenfield7
Demand forecast (30 years)~30,000 new homes7
Key constraintTopography (downslope sewerage limitations)
Years of supply (some areas)35–40 years on paper (e.g., Scottsdale)

Australian Capital Territory

The ACT manages residential land releases through its Housing Supply and Land Release Program, which sets out a five-year plan for new housing. The 2025–26 to 2029–30 program plans for 25,948 new homes, with at least 70 per cent of new housing planned within existing urban areas.8

The program also aims to allocate at least 15 per cent of suitable residential land released each year to public, community and affordable housing, rising to 20 per cent in 2025–26.8

Land development delays and rising construction costs have affected housing delivery. In Denman Prospect, 40 residential blocks were advertised for between $549,000 and $1,450,000 as at 23 October 2026, with a median asking price of $770,000.9

MetricData
New homes targeted (2025–26 to 2029–30)25,948 via ILRP8
Infill targetAt least 70% of new housing within the existing urban footprint (program principle under the ACT Planning Strategy)8
Public, community and affordable housingAt least 15% of suitable annual releases; 20% in 2025–268
Block asking prices (Denman Prospect, 23 Oct 2026)$549,000–$1,450,000; median $770,000 (40 blocks listed)

Northern Territory

The NT has faced delays in bringing land to market. A government review led to 23 recommendations; 15 have been actioned to reduce regulatory barriers and speed up approvals10. The Land Development Corporation (LDC) delivers residential land in Zuccoli, Kilgariff and Fannie Bay.

New home construction starts fell below 100 per quarter in late 2023, the lowest in 30 years. Earlier forecasts projected a recovery to 730 homes in 2024–25, followed by 990 in 2026–27.

MetricData
Land pipeline20-year forward forecast via Land Development Strategy
Development-ready land"Land Under Development": developer-held with connected services
Forecast commencements730 in 2024–25; 990 in 2026–27
Key delivery bodyLand Development Corporation (LDC)

Section 02 · Greenfield and infill

Greenfield vs infill housing targets in Australia by state

Several states and territories have set targets to increase the share of housing delivered through infill development, including apartments and townhouses in established suburbs. These policies are designed to reduce reliance on outer-fringe greenfield estates, where new roads, schools, water and sewerage infrastructure are often required.

JurisdictionTarget Ratio (Infill : Greenfield)Status
ACTAt least 70% : 30%8ACT Planning Strategy target (program principle)
Tasmania70% : 30%7Greater Hobart Plan mandate
Queensland70% : 30%ShapingSEQ 2023 target
South Australia~67% : 33%Historically achieved
Western AustraliaHigher target; 39% achievedBelow long-term target
NSWFocus on TOD & LMR policiesPolicy-driven shift

Apartment and townhouse projects can be more difficult to deliver where construction costs, planning requirements, labour availability and project feasibility affect development timelines. In some markets, these factors may limit how quickly infill housing can be added compared with greenfield estates.

Section 03 · Land supply

What do years of residential land supply mean in Australia?

Years of residential land supply estimate how long available land could meet future housing demand. Figures vary sharply between states and are calculated differently. They often measure potential housing capacity rather than land that is ready for development.

How many years of residential land supply does each state have?
JurisdictionReported Years of SupplyHow It's Calculated
WA~26 yrs (Perth / Peel); 55 yrs (Greater Bunbury)Undeveloped urban-zoned land divided by the 20-year historical annual consumption rate.
SA15+ yrs (Greater Adelaide — statutory minimum)139,000 zoned allotments measured against average demographic growth rates.
VIC (Regional)Up to 31 yrs (e.g., Horsham)Zoned capacity under current land use settings divided by upside demand scenarios (e.g., 82 dwellings/year).
TAS35–40 yrs (e.g., Scottsdale)Identified residential lots measured against localised population forecasts.
NSW6.4 yrs (Sydney Mega-Region); 3.2 yrs (Greenfield only)Unconstrained zoned land measured against annual delivery rates required by the Housing Accord.
QLDMin. 15 yrs (Planned supply); Min. 4 yrs (Approved supply)Statutory minimums tracked by the Growth Monitoring Unit against projected demand under ShapingSEQ.
ACTRolling 5 yrs (Overall supply); ~12 yrs (Multi-unit infill)Managed via the ILRP rolling release plan, with infill capacity modelled against current demographics.
NT11 yrs (Greater Darwin); 8 yrs (Katherine); 27 yrs (Tennant Creek)"Land Under Development" (developer-held, infrastructure connected) measured against NT Treasury demand forecasts.

How do infrastructure delays affect residential land supply?

Land generally needs roads, water and sewerage before housing can be delivered. In Sydney's Mega-Region, 59 per cent of zoned land is constrained because supporting infrastructure has not yet been funded. Until funding and delivery arrangements are resolved, some zoned land may remain unavailable for development.

How do environmental restrictions affect residential land supply?

Broad zoning maps do not always capture environmental constraints. Western Australia adjusts its land supply figures using environmental constraint groups, while other states report these constraints differently. In some areas, biodiversity requirements can reduce the amount of zoned land that is practical or feasible to develop.

How do land ownership and terrain affect housing development?

Some large residential land parcels are split across multiple owners, which can slow land assembly and subdivision. Site conditions can also affect delivery. In Tasmania, for example, steep terrain can make standard sewerage connections difficult, reducing the amount of land that is practically development-ready.

References

  1. UDIA NSW, Lower Hunter Building Blocks 2025 Refresh · udiansw.com.au ↑
  2. Victorian Urban Development Program 2025 · planning.vic.gov.au ↑ b c d e
  3. Local Government Association of Queensland, Submission IR-053 to the Queensland Productivity Commission inquiry into housing (interim report response) · Local Government Association of Queensland ↑ b
  4. Economic Development Queensland, Coordinated infrastructure planning to support greenfield housing delivery · edq.qld.gov.au ↑ b
  5. Economic Development Queensland, 2024–25 Snapshot · edq.qld.gov.au ↑ b
  6. WA Urban Growth Monitor Report 17 · dplh.wa.gov.au ↑ b c d e f g h i j k
  7. 30-Year Greater Hobart Plan · hobartcity.com.au ↑ b c d e
  8. ACT Housing Supply and Land Release Program 2025-26 to 2029-30 · act.gov.au ↑ b c d e f
  9. Denman Prospect price list, 23 October 2026 · denmanprospect.com.au ↑
  10. Northern Territory Department of Lands, Planning and Environment, Land development process report and recommendations · Northern Territory Government ↑
  11. NSW Urban Development Program (UDP) · planning.nsw.gov.au
  12. Queensland Growth Monitoring Unit / QGSO Broadhectare Studies · qgso.qld.gov.au
  13. SA PlanSA — Land Supply Monitoring · plan.sa.gov.au
  14. NT Land Development Strategy · ldc.nt.gov.au
  15. NHSAC State of the Housing System 2026 · nhsac.gov.au
  16. Urban Development Institute of Australia, State of the Land 2026, released March 2026 · udia.com.au
