Updated
- Accord target
- 1.2M
- New homes by 30 June 2029
- Original annual pace
- 240,000
- Completions every year, July 2024 to June 2029
- Actual completions FY2025–26
- 180,500
- 24.8% below the original annual pace
- Annual shortfall (FY2025–26)
- 59,500
- Homes below the 240,000 target pace
Is Australia on track to build 1.2 million homes by June 2029?Australia completed 355,817 homes in the first two years of the National Housing Accord, compared with the 480,000 needed to stay on track.
Australia’s 1.2 million homes target: progress, funding, and who is responsibleAustralia is behind the straight-line pace needed to build 1.2 million new homes by June 2029. The target requires an average of 60,000 completions per quarter over five years. Over the first eight…Section 01 · target
How many homes does Australia need to build each year to meet the 1.2 million target?
The target of 1.2 million homes over five years requires 240,000 completions per year. Australia has never built that many homes in a single year. The highest annual total was 219,052 in 2016–173.
The Accord originally required 240,000 completions a year, or about 20,000 homes a month, from July 2024 to June 2029. Because the first eight quarters fell short, Australia now needs closer to 281,200 completions a year to catch up.
The August 2026 report from the National Housing Supply and Affordability Council (NHSAC) recorded 308,000 completions between July 2024 and March 20262. Adding the 47,653 homes completed in the June 2026 quarter brings the total to about 356,0001, leaving roughly 844,000 homes still needed by June 2029.
To reach the target, Australia would need to complete about 70,300 homes each quarter, or 281,200 a year. That is about 17 per cent more than the original annual target.
| Australia's housing target and progress | ||
|---|---|---|
| Measure | Value | Note |
| National Housing Accord target | 1,200,000 | Gross completions, 1 July 2024 to 30 June 2029 |
| Straight-line annual pace | 240,000/yr | 1.2M divided by 5 years |
| Straight-line quarterly pace | 60,000/qtr | 1.2M divided by 20 quarters |
| Homes completed (first 8 quarters) | 356,000 | ABS Building Activity, June quarter 2026 (original series) |
| Homes still needed by June 2029 | 844,000 | 1.2M minus 356,000 |
| Required catch-up pace | 70,300/qtr | 844,000 divided by 12 remaining quarters |
| Required annualised catch-up pace | 281,200/yr | 70,300 multiplied by 4 |
Source · Treasury housing pages, May 2026; NHSAC Quarterly Report, August 2026; ABS Building Activity, June quarter 2026. Catch-up pace calculated by dividing remaining target (1.2M minus 356,000) by the 12 quarters remaining to June 2029.

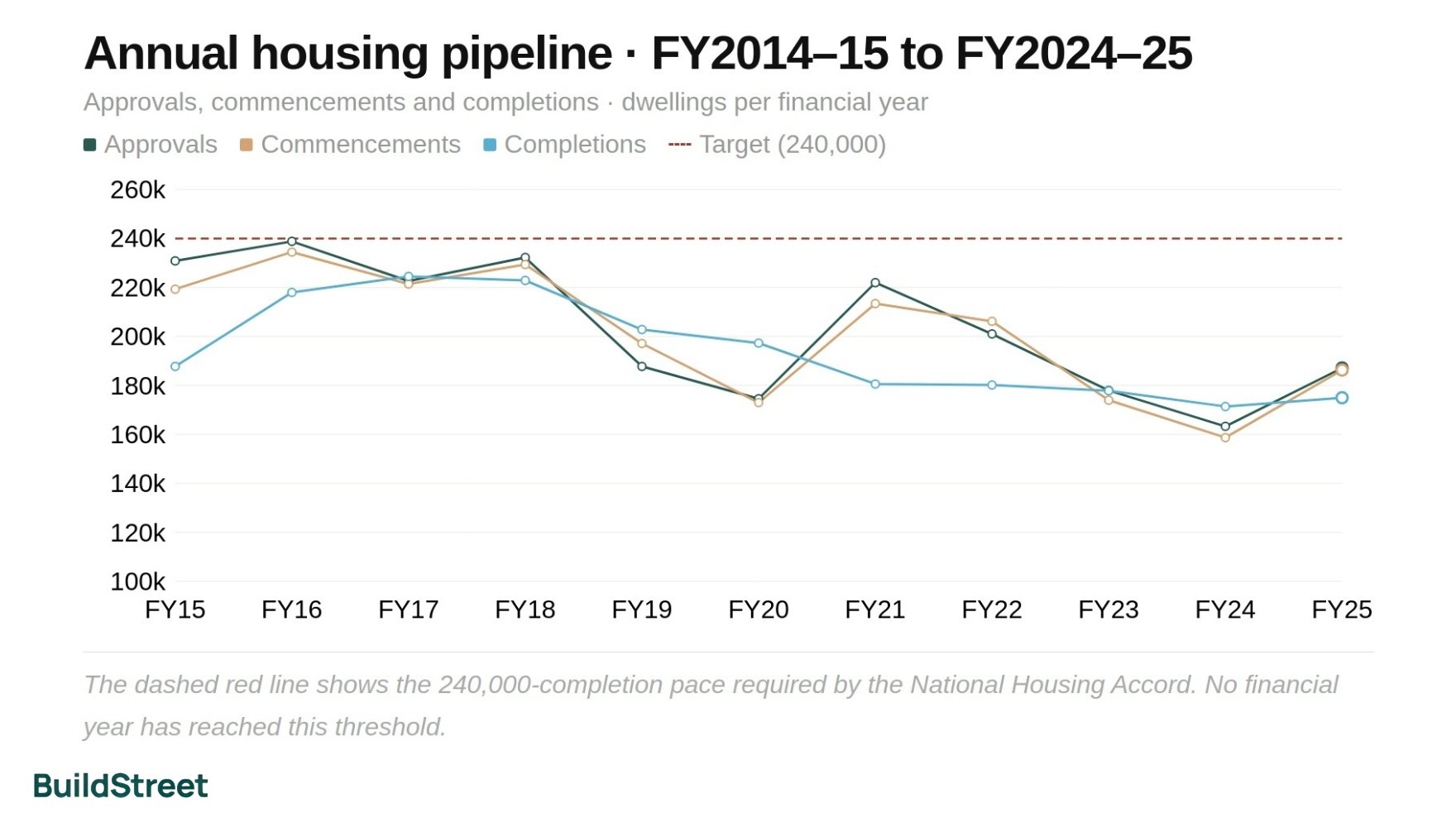

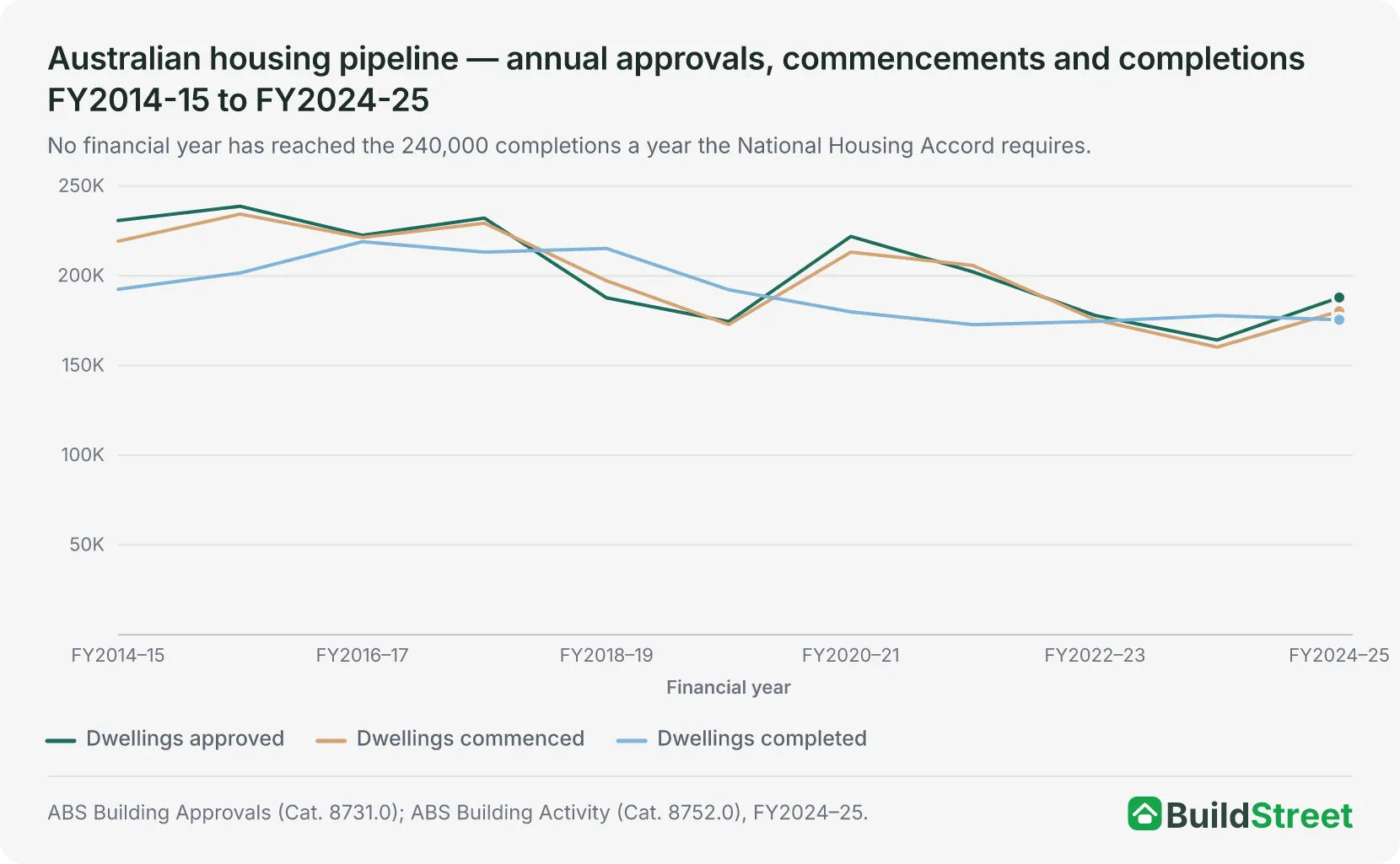

Section 02 · completions
How many homes did Australia build in 2025–26?
Australia completed 180,500 homes in 2025–26, up 2.8 per cent from 175,510 the previous year3.
Approvals increased by 9.4 per cent to 205,5934, and construction started on 204,440 homes, up 13.4 per cent5. However, only completions count towards the Accord target, and they rose only slightly.
The year-by-year data on Australian building approvals shows that completions have never reached the 240,000 homes needed each year to meet the target.
Although more homes are being approved and construction is starting on more projects, the increase in completed homes has been much smaller.

In the June 2026 quarter, construction started on 52,201 homes, compared with 47,168 completions (seasonally adjusted)1. The number of homes under construction also rose to a record 248,733, up from 224,571 a year earlier, suggesting that construction is starting on homes faster than they are being completed.
Section 03 · forecast
Is Australia on track to build 1.2 million homes by 2029?
Australia is not on track to build 1.2 million homes by June 2029, although the latest forecast has improved. The National Housing Supply and Affordability Council (NHSAC) raised its projected five-year total from 938,000 to 980,000 homes in 2026, based on conditions before the Middle East conflict6, equal to 82 per cent of the target. The Council's August 2026 report estimates that Australia will reach the target in December 2030, 18 months after the Accord deadline2.
- NHSAC 2025 forecast
- 938,000
- 78% of target; shortfall of 262,000 homes
- NHSAC 2026 forecast
- 980,000
- 82% of target; improved but still 220,000 short
- Jun qtr 2026 completions
- 47,168
- 32.9% below the 70,300 catch-up quarterly rate now needed
- Expected national completion
- Dec 2030
- 18 months past the June 2029 Accord deadline
The improved forecast still leaves Australia 220,000 homes short of the target6. There is also a risk of a larger shortfall, with NHSAC modelling suggesting that higher fuel and petrochemical costs could reduce completions by between 10,000 and 33,000 homes before June 2029.
Approvals for the full 2025–26 year totalled 205,593 dwellings4, below the original annual target of 240,000 and the catch-up pace now required. Detailed state-level progress and scenario forecasts are in the National Housing Accord progress tracker.
Section 04 · causes
What is slowing housing construction in Australia?
Australia is falling behind its housing target because of several connected problems. These include low building approval numbers, labour shortages, rising costs, longer construction times and difficulties financing new homes. Planning restrictions and delays in making land available for housing also affect supply.
- Approvals still below pace
- 205,593
- FY2025–26 approvals, 34,407 below the 240,000 annual target pace.
- Longer build times
- 33 months
- Average apartment completion, FY2025–26; under 21 months in FY2014–15.
- Labour shortages
- 20,000
- Construction vacancies in August 2026, up from 16,600 before the pandemic.
- Material costs still rising
- +4.9%
- Building construction output price, year-on-year to June 2026.
Building approvals are not high enough
Building approvals provide an early indication of future housing construction, but they remain below the level needed to meet the target. Australia approved 205,593 homes in 2025–264, which was 34,407 fewer than the annual target of 240,000.
Monthly approvals varied during 2026 but remained below the 20,000 homes a month needed under the original target (seasonally adjusted):
Fewer approvals now could mean fewer completed homes in the coming years, as construction takes time once a project is approved.

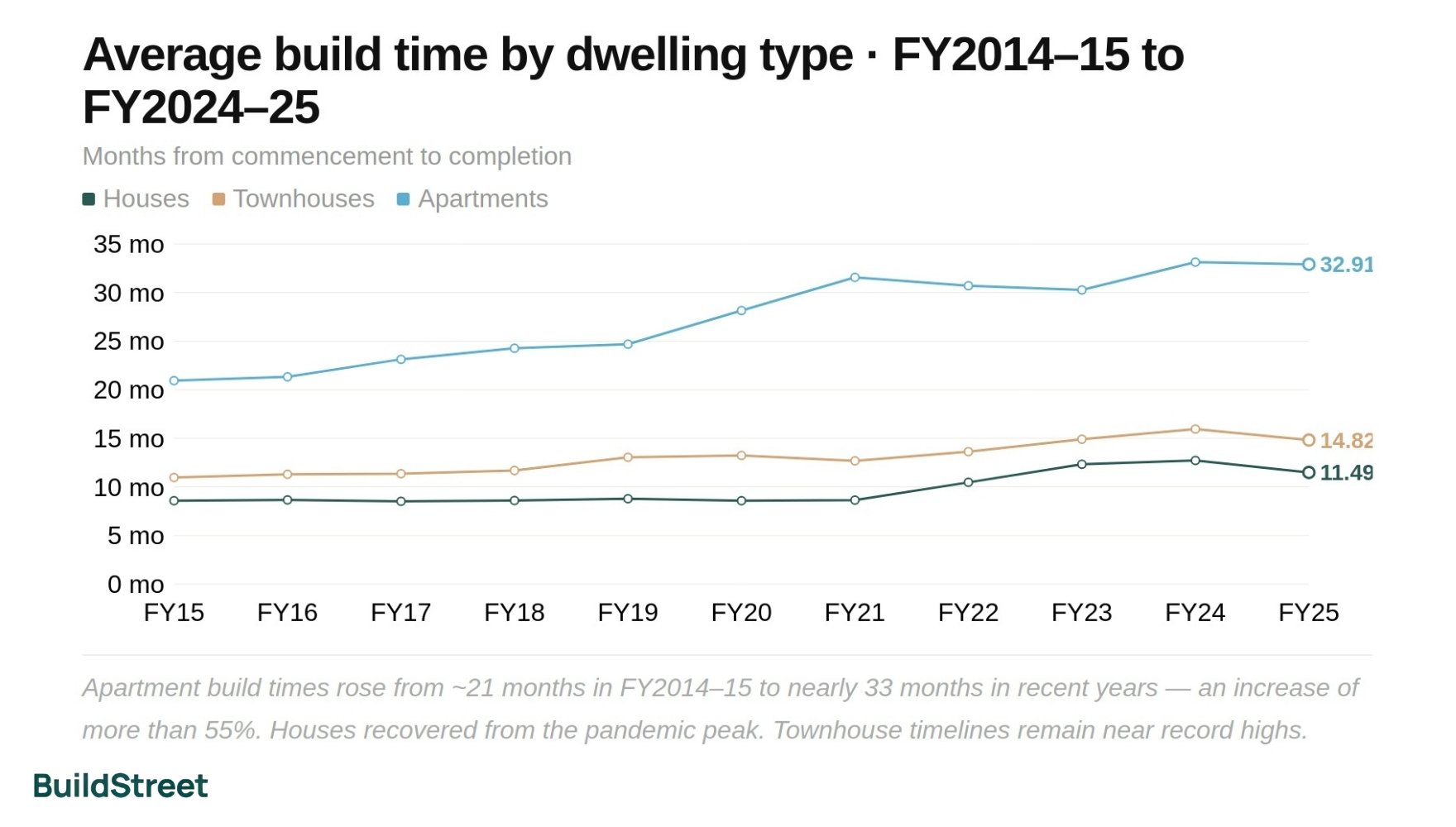

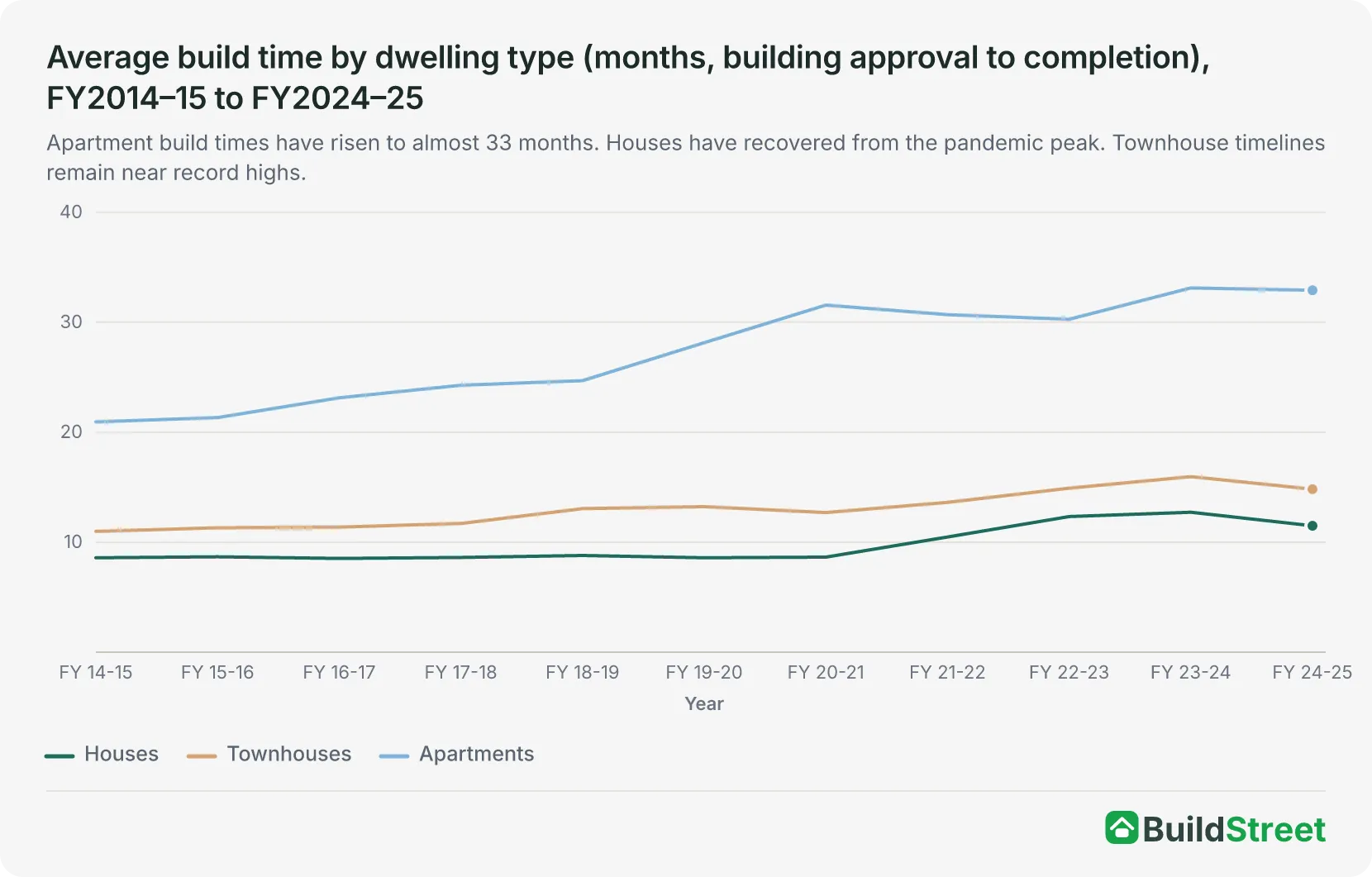

Homes are taking longer to build
The average house took 10.7 months from building approval to completion in 2025–268, an improvement from the pandemic-era peak of 12.72 months9. Townhouses still averaged around 14 months and apartments around 33 months8, compared with roughly 9 months for a new house in 2019–209.
Longer construction times mean homes take longer to become available. They can also increase financing costs as builders and developers cover expenses over a longer period.

Labour shortages are slowing construction
There were 20,000 construction job vacancies in August 202610, up from 19,500 in August 2025 and 20 per cent above the 16,600 recorded before the pandemic in February 202011.
Nearly half of all trade occupations were identified as being in shortage12, with construction particularly affected. Although shortages have eased since the pandemic, they continue to limit how quickly new homes can be built.
Building material costs remain high
Building construction output prices rose 4.9 per cent in the year to June 202613, and prices for new homes rose 5.4 per cent in the year to August 202614.
Price increases have slowed considerably since 2021–22, but construction remains more expensive than before the pandemic.
| Cost measure | Year-on-year change (June quarter 2026; CPI to August 2026) |
|---|---|
| Input prices for house construction | +3.8% |
| Output price of building construction | +4.9% |
| House construction output price | +5.9% |
| Other residential building construction | +4.1% |
| CPI: new dwelling prices | +5.4% |
Source · ABS Producer Price Indexes (Cat. 6427.0), June quarter 2026 (annual change to June 2026); ABS Consumer Price Index (Cat. 6401.0), August 2026 (annual change to August 2026).
Higher interest rates made projects harder to finance
The Reserve Bank of Australia's cash rate target was 4.60 per cent from 30 September 202615, after four increases in 2026. Small business lending rates were also high, at 7.47 per cent on outstanding loans and 7.23 per cent on new loans in August 202616.
Housing projects often require substantial borrowing before construction is completed. Higher interest rates increase financing costs and can make some projects less financially viable.
Builder insolvencies reduced industry capacity
The number of companies entering external administration for the first time was 14,153 in 2025–26, down 3.9 per cent from 14,722 in 2024–2517 but still well above the 11,053 of 2023–24. Construction accounted for the largest share, with 3,472 companies, or 24.5 per cent of all first-time administrations.
Builder insolvencies can delay or interrupt housing projects, reducing the industry's ability to complete new homes.
Apartment construction has not recovered enough
Higher-density homes accounted for 36.6 per cent of all new construction starts in the June 2026 quarter, with 19,126 commencements out of 52,201 (seasonally adjusted)1. However, annual apartment approvals remain below the mid-2010s peak.
Apartments take around 33 months8 on average from approval to completion9. This means projects approved in 2026 may not be completed before the June 2029 deadline. Without a sustained increase in apartment construction, Australia is unlikely to reach the housing target through detached houses alone.
Land release and infrastructure are slowing new housing supply
Australia's housing plans include measures to improve planning, zoning, land availability and building approvals, with a focus on medium- and high-density housing in areas close to transport, jobs and services.
A separate $3.5 billion Housing Support Program18, including a $2 billion Local Infrastructure Fund announced in the 2026–27 Budget, provides funding for infrastructure and planning improvements to support new housing development.

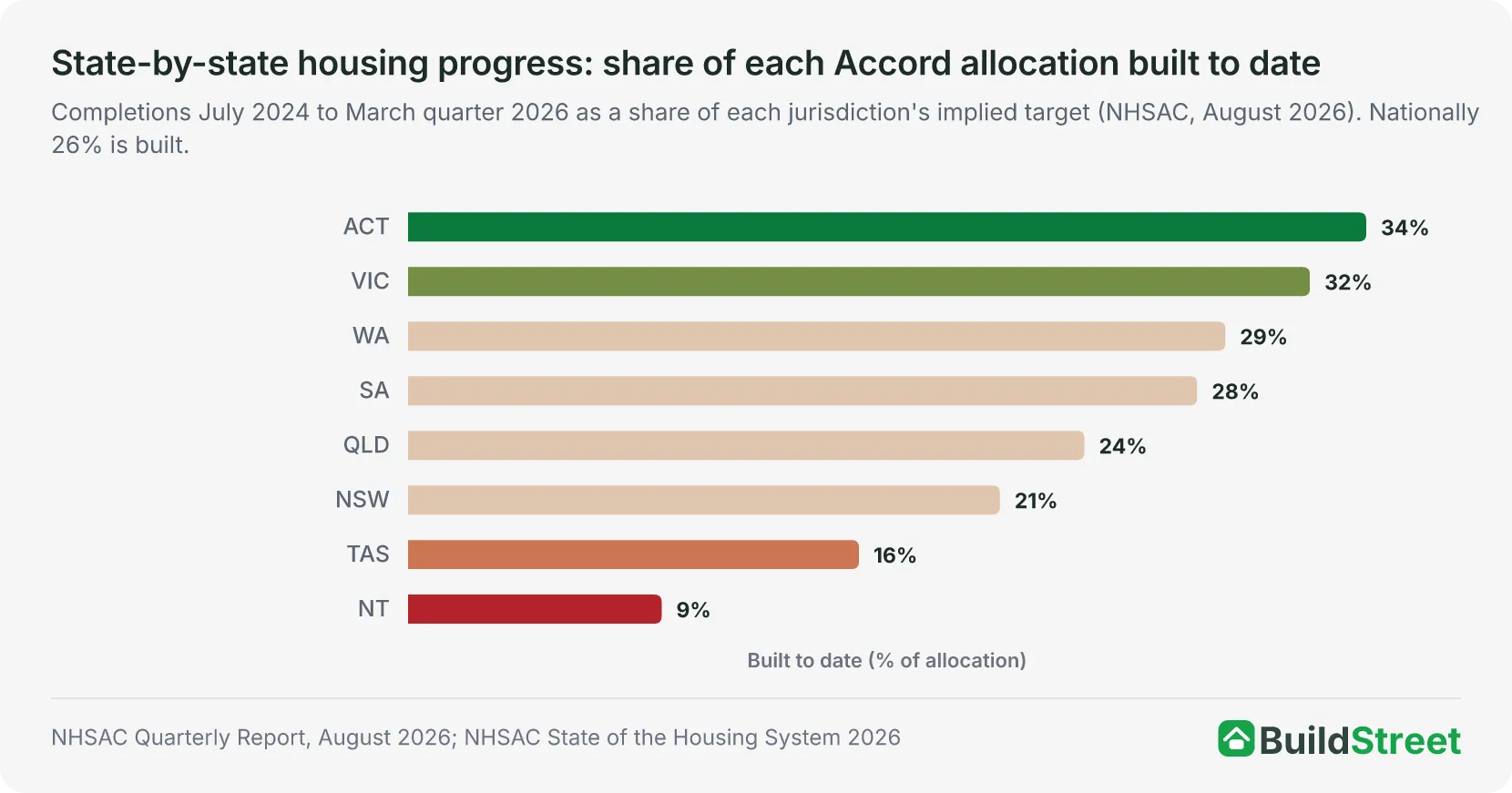

Section 05 · states
Which states are furthest behind on housing supply?
New South Wales has the largest housing shortfall in numbers. Just 21 per cent of its 376,000-home target6 had been completed by March 2026, and the state is not expected to reach its target until March 20322.
In percentage terms, the Northern Territory and Tasmania are even further off the pace.
- Northern Territory: 9 per cent built, projected past 20342
- Tasmania: 16 per cent built, projected June 20342
- New South Wales: 21 per cent built, projected March 20322
The Council's earlier 2026 forecast suggested that the Australian Capital Territory (ACT) and Western Australia were the only jurisdictions likely to meet their share of the target6. However, its August 2026 report now expects every state and territory to miss the June 2029 deadline2. The ACT, Victoria and Western Australia are expected to come closest, reaching their targets in December 2029.

| Housing target progress by state and territory | |||||
|---|---|---|---|---|---|
| State / territory | Implied target | Built to date | Approved to date | 2026 forecast | Expected completion |
| New South Wales | 376,000 | 21% | 27% | 69% | Mar 2032 |
| Victoria | 306,000 | 32% | 37% | 94% | Dec 2029 |
| Queensland | 246,000 | 24% | 35% | 83% | Mar 2031 |
| Western Australia | 129,000 | 29% | 38% | 100% | Dec 2029 |
| South Australia | 84,000 | 28% | 35% | 78% | Mar 2031 |
| Tasmania | 26,000 | 16% | 20% | 51% | Jun 2034 |
| Australian Capital Territory | 21,000 | 34% | 33% | 103% | Dec 2029 |
| Northern Territory | 11,000 | 9% | 14% | 34% | After 2034 |
| Australia (national) | 1,200,000 | 26% | 33% | 82% | Dec 2030 |
Section 06 · apartments
Why are apartments important to Australia's housing target?
Apartments are important to Australia's housing target because detached houses alone are unlikely to provide the number of homes needed.
Higher-density homes accounted for 36.6 per cent of all new construction starts in the June 2026 quarter, with 19,126 of 52,201 new homes (seasonally adjusted) falling into this category1. Without a sustained increase in higher-density housing, Australia is likely to remain below the pace needed to meet the target.
The national housing plan focuses on building more medium- and high-density homes in areas close to transport, jobs and services. New South Wales and Victoria, which have large housing targets, rely heavily on apartments and townhouses in established areas where land for detached houses is limited.
- Higher-density commencements (Jun qtr 2026)
- 19,126
- 36.6% of all commencements that quarter
- Average apartment build time
- 33 months
- vs 10.7 months for a new house in FY2025–26
- Higher-density approvals (Aug 2026, seas. adj.)
- 5,674
- Monthly figure: volatile and still below what the target needs
Section 07 · affordability

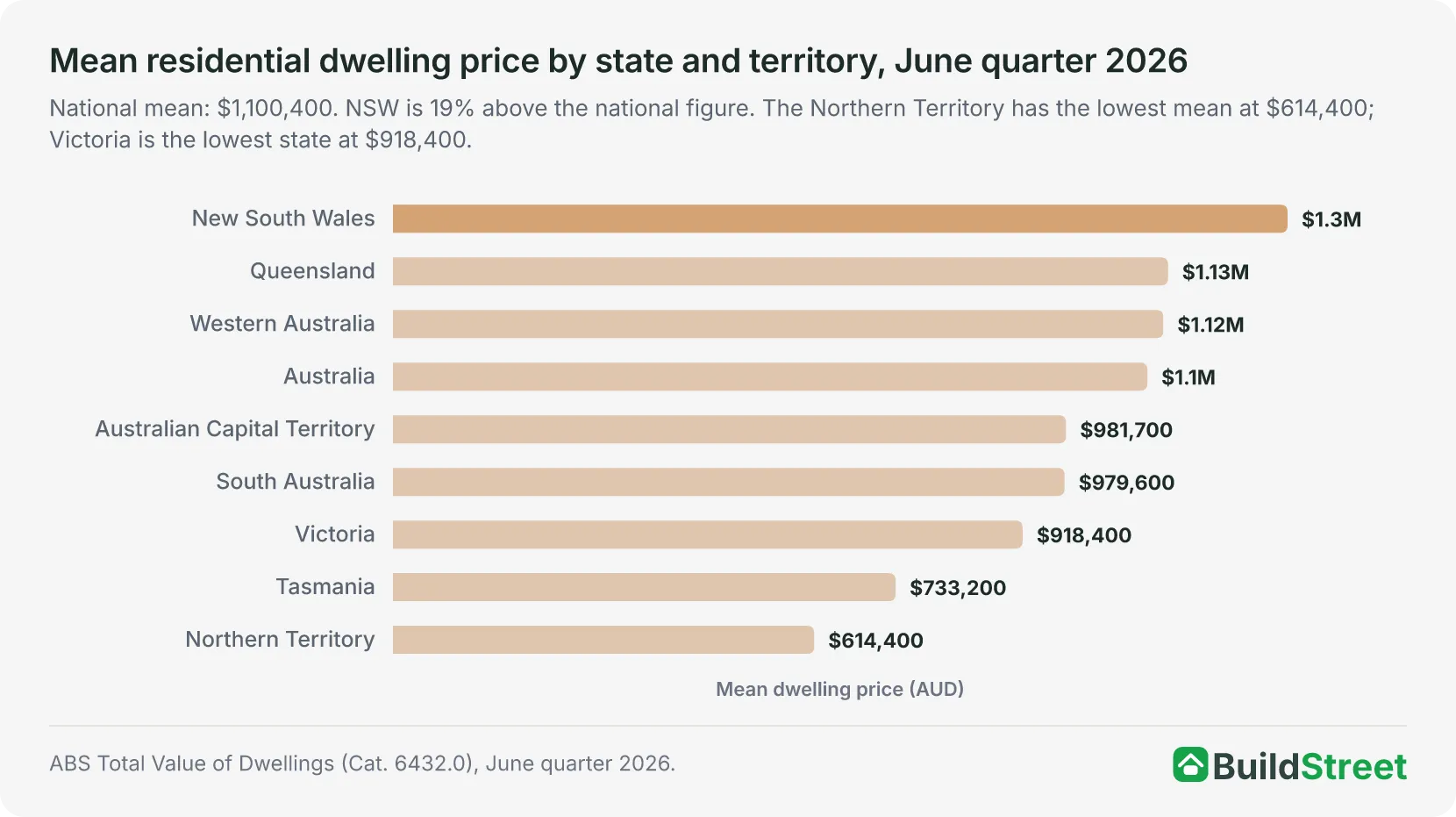

How does Australia's housing shortage affect buyers and renters?
Australia's housing shortage is adding to affordability pressures for buyers and renters. The national mean dwelling price was $1,100,400 in the June 2026 quarter19. New South Wales had the highest state average at $1,304,900, around 19 per cent above the national figure and $174,000 higher than in Queensland, the next most expensive state.
These figures represent average dwelling values across all residential properties, rather than median sale prices. They provide a broad measure of housing values but do not show what buyers typically pay for a home.

For renters, conditions have improved from earlier peaks in rental pressure, but affordability remains a concern. Rents rose 3.6 per cent over the year to August 202614, while rental vacancy rates remained low across capital cities.
Around 1.38 million households and individuals received Commonwealth Rent Assistance in the March 2026 quarter20. Of those, approximately 608,000 (44 per cent) were still spending more than 30 per cent of their gross income on rent after receiving assistance.
- Rent inflation
- +3.6%
- Year-on-year to August 2026; driven by low vacancy rates
- CRA recipients
- 1.38M
- Income units receiving Commonwealth Rent Assistance, Mar qtr 2026
- In rental stress after assistance
- 44%
- Around 608,000 income units still spent more than 30% of gross income on rent.
- Social housing waitlist
- 206,000
- Households on the consolidated social housing waitlist at 30 June 2025
The shortage of new housing affects buyers, renters and households seeking social housing. High property values, rental costs and demand for affordable homes continue to place pressure on different parts of the housing market.
Section 08 · outlook
What needs to change for Australia to meet its housing target?
Australia is not on track to deliver 1.2 million homes by June 2029 at the current rate of construction, but the outlook has improved.
The National Housing Supply and Affordability Council (NHSAC) estimates around 980,000 completions by June 2029, based on conditions before the Middle East conflict6, with the full 1.2 million homes expected by December 20302.
The 2026 forecast is stronger than the previous year's outlook, which projected 938,000 homes6. The revised forecast represents 82 per cent of the target, leaving an expected shortfall of 220,000 homes by June 2029.
There is also a risk of a larger shortfall. NHSAC modelling suggests that higher fuel and petrochemical costs could reduce completions by between 10,000 and 33,000 homes before June 20296.
| Australia's housing target forecasts | |||
|---|---|---|---|
| Scenario | Projected homes | % of target | Expected date to reach 1.2M |
| NHSAC 2025 forecast | 938,000 | 78% | Not modelled |
| NHSAC 2026 forecast | 980,000 | 82% | December 2030 (August 2026 update) |
| Higher fuel and petrochemical cost scenario | 947,000–970,000 | 79–81% | Later than the main forecast |
| Accord target | 1,200,000 | 100% | June 2029 |
Source · NHSAC State of the Housing System 2025 and 2026; NHSAC Quarterly Report, August 2026.
