Updated
Australia's construction workforce has reached a record 1.39 million workers,1 but the sector is still short of the trades needed to keep up with housing demand. Core residential trades are in shortage across states and territories, while job vacancies remain above pre-pandemic levels.
The strain is showing in the delivery numbers. House build times have risen from 2.18 quarters in 2019-20 to 2.80 quarters in 2025-26, apartment build times have reached a record 9.54 quarters, and construction costs are now 42% above their 2019 level.
- Construction workforce
- 1.39M
- Trend employment, Aug 2026, a record high
- Job vacancies (Aug 2026)
- 20,000
- 20% above the 2019 annual average
- Trades in national shortage
- 12 of 15
- Core housing trades tracked, JSA 2026 Occupation Shortage List
Is Australia on track to build 1.2 million homes by June 2029?Australia completed 355,817 homes in the first two years of the National Housing Accord, compared with the 480,000 needed to stay on track.
How long does it take to build a house in Australia?The average time from approval to handover is now about 10.7 months for a house, 13.8 months for a townhouse and almost 33 months for an apartment in Australia.Section 01 · Shortage overview
How many construction workers does Australia have?

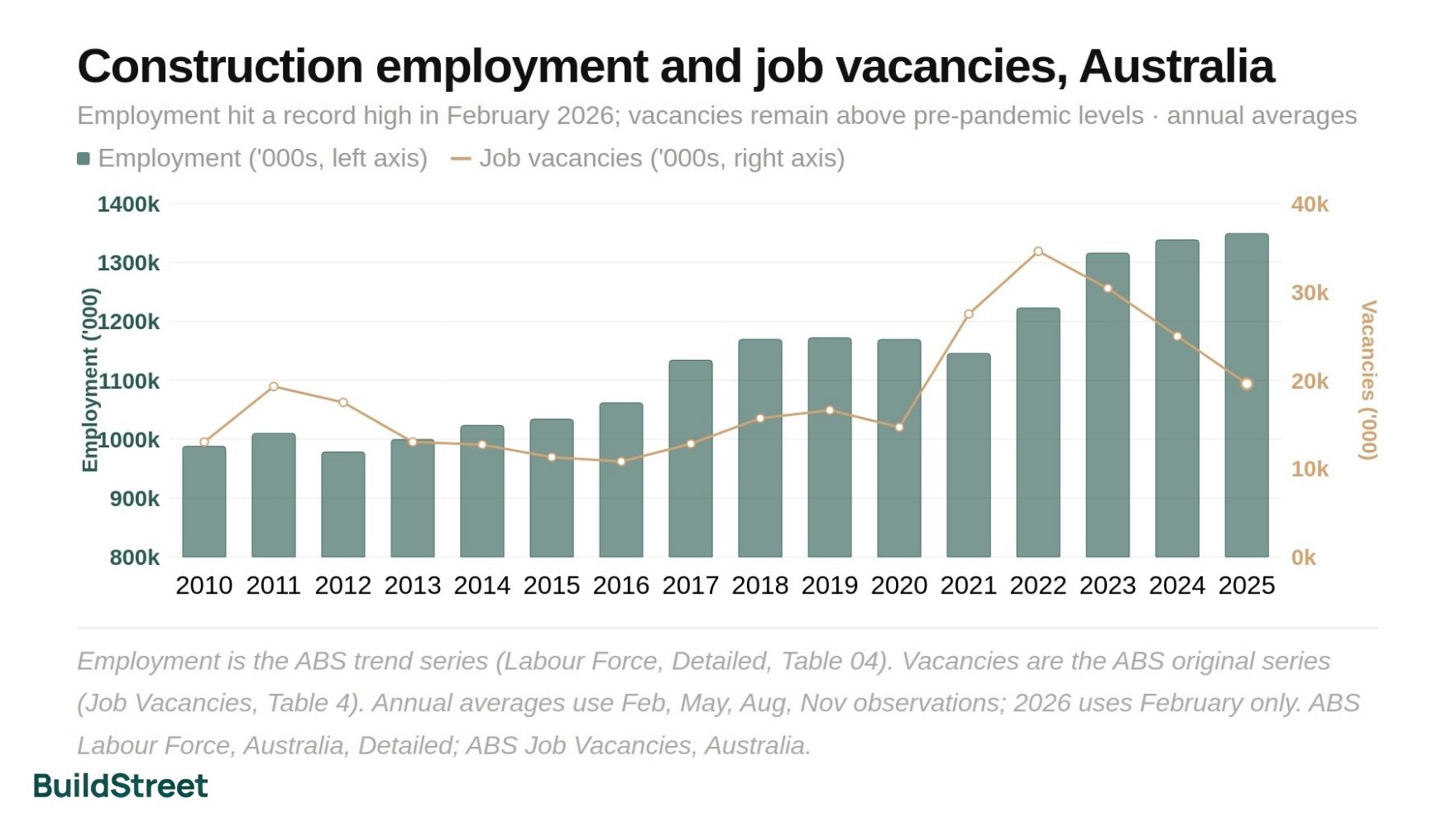

The construction industry employed a record 1.39 million workers in August 20261, and still could not fill 20,000 job vacancies in August 20262. Even after falling 50% from the May 2022 peak, vacancies remain 20% above the 2019 annual average.
Construction is classified as an industry under heightened shortage pressure. Nationally, 27% of assessed occupations were in shortage in 2026, down from 29% in 2025 and the 2023 peak of 36%, and tradespeople and technicians account for 54% of the 127 occupations in shortage on every list since 20213.
Against that backdrop, 12 of 15 core residential trades are in national shortage on the 2026 list4.

Section 02 · Trades in shortage
Which construction trades are in shortage in Australia?
Of the 15 core residential building trades tracked, 12 are in national shortage on Jobs and Skills Australia's 2026 Occupation Shortage List4. Construction Project Manager moved to a regional shortage only, while Project Builder and Building Associate are not in shortage. The 2026 list gives national ratings only, so the state coverage shown in this article is from the 2025 list, the latest with state ratings. The shortage type differs by trade, and that distinction matters for how each gap can be closed.
The trades divide into three shortage types, each requiring a different response.
| Trade group | 2026 national status | State coverage (2025 list) | Main shortage driver (2026) | Employment (unit group) |
|---|---|---|---|---|
| Carpenters and joiners | Shortage | All 8 jurisdictions | Education and training gap | 149,600 |
| Electricians | Shortage | All 8 jurisdictions | Suitability gap | 197,300 |
| Plumbers | Shortage | All 8 jurisdictions | Education and training gap | 107,600 |
| Bricklayers and stonemasons | Shortage | All 8 jurisdictions | Retention gap | 25,800 |
| Plasterers and renderers | Shortage | All 8 jurisdictions | Retention gap | Not specified |
| Wall and floor tilers | Shortage | All 8 jurisdictions | Retention gap | Not specified |
| Painters | Shortage | All 8 jurisdictions | Not reported | Not specified |
| Roof tilers | Shortage | All 8 jurisdictions | Not reported | 9,400 |
| Construction project managers | Regional shortage only | All 8 jurisdictions | Suitability gap | 134,300 |
| Building associates | No shortage | NT only | Not specified | Not specified |
Source · Jobs and Skills Australia 2026 Occupation Shortage List (national ratings) and 2026 Occupation Shortage Drivers Report; state coverage from the 2025 Occupation Shortage List, the latest with state ratings; employment from JSA occupation profiles (unit groups).
Carpenters and joiners
With 149,600 employed nationally and median full-time weekly earnings of $1,7605, carpenters and joiners are one of the largest shortage groups in the country. Jobs and Skills Australia's 2026 analysis puts the main shortage driver down as an education and training gap6: too few people are starting, finishing and applying with the qualification. NSW accounts for 32.3% of the workforce, Victoria 29.9%, and Queensland 19.2%.
Electricians
Electricians are the largest of the shortage trades, with 197,300 employed on median full-time weekly earnings of $2,1917. The shortage is classified as a suitability gap. There are applicants, but employers report that candidates frequently lack the specific experience, site readiness, or capability that roles require.
Plumbers
Plumbing is an education and training gap shortage. The category applies where too few people are starting, finishing and applying with the qualification, and the plumbing pathway is long, typically a Certificate III or above, taking three to four years. This means even a significant lift in apprenticeship starts today will not relieve the shortage quickly. The plumber unit group employs 107,600 workers8 across all plumbing subcategories.
Bricklayers and stonemasons
Bricklaying employs around 25,800 workers nationally9, smaller than carpentry or electrical, but critical to the sequence of a build. Without completed brickwork, trades that follow cannot begin work. Its main shortage driver in 2026 is a retention gap, only narrowly ahead of an education and training gap6, and it remains in national shortage.
Plasterers, tilers, painters, and roofers
All finishing trades are in national shortage. Plasterers, renderers, and wall and floor tilers are retention gap shortages; the 2026 drivers report does not name a main driver for painters or roof tilers. Roof tilers employ around 9,400 workers nationally10. That is a small enough workforce that even a modest lift in demand can create a bottleneck at the final stages of a build.
Construction managers
The management layer is also under pressure. Construction project managers moved from a national shortage in 2025 to a regional shortage only in 2026. The construction managers unit group employs 134,300 people on median full-time weekly earnings of $3,75111, and its main shortage driver is a suitability gap. Building associates are not in national shortage; on the 2025 list they were short only in the Northern Territory.
The three causes behind construction trade shortages
Construction labour shortages have three distinct causes, and each requires a different response. An education and training gap means too few people are moving through the qualification pipeline. A suitability gap means candidates exist but lack the job-readiness employers need. A retention gap means workers are leaving faster than they can be replaced.
Education and training gap: carpenters and joiners, plumbers
Too few qualified applicants per vacancy, and the qualification pathway takes years. Even large increases in apprenticeship starts cannot close this gap quickly. Closing it depends on a larger and steadier flow of completions.
Suitability gap: electricians, construction managers
There may be enough nominally qualified people, but employers cannot fill roles because candidates lack the specific experience, site readiness, or job-readiness required. More supply alone does not solve a suitability gap. Closing it depends on a closer match between training outcomes and employer expectations.
Retention gap: bricklayers, plasterers and renderers, wall and floor tilers
People are entering these trades but not staying. Retention shortages are linked to working conditions, pay, culture, and access barriers. Attracting more entrants does not fix a retention problem if the conditions that drove the previous cohort out remain unchanged.
Housing construction also competes with a large public infrastructure pipeline for the same workers. Infrastructure Australia forecasts $1.14 trillion of construction activity nationally over the five years to 2028-29, including a $242 billion five-year public infrastructure pipeline12. Housing and infrastructure are drawing from the same constrained workforce through to at least 2029.
Section 03 · State breakdown
Construction trade shortages: a state-by-state breakdown
On the 2025 Occupation Shortage List, the latest with state ratings, the Northern Territory had the broadest shortage profile, with 19 of 19 tracked trades affected, followed by Western Australia at 18 of 19. NSW, Victoria, Queensland, and South Australia each recorded 17 of 19 in shortage, with Tasmania and the ACT at 16 of 19.
The practical workforce gap is largest in NSW, Victoria, and Queensland, which account for 81.4% of all carpenters and joiners and 80.3% of all construction project managers nationally. The shortage is widest in NT and WA by count, but the scale of unmet demand is greatest where most new housing needs to be built.
| Occupation shortage status by state and territory, 2025 | |||||||||
|---|---|---|---|---|---|---|---|---|---|
| Trade | NSW | VIC | QLD | SA | WA | TAS | ACT | NT | National |
| Carpenter and Joiner | S | S | S | S | S | S | S | S | S |
| Carpenter | S | S | S | S | S | S | S | S | S |
| Joiner | S | S | S | S | S | S | S | S | S |
| Bricklayer | S | S | S | S | S | S | S | S | S |
| Stonemason | S | S | S | S | S | S | S | S | S |
| Painter | S | S | S | S | S | S | S | S | S |
| Plasterer | S | S | S | S | S | S | S | S | S |
| Renderer | S | S | S | S | S | S | S | S | S |
| Roof Tiler | S | S | S | S | S | S | S | S | S |
| Wall and Floor Tiler | S | S | S | S | S | S | S | S | S |
| Plumber (General) | S | S | S | S | S | S | S | S | S |
| Electrician (General) | S | S | S | S | S | S | S | S | S |
| Construction Project Manager | S | S | S | S | S | S | S | S | S |
| Project Builder | NS | NS | NS | NS | S | NS | NS | S | NS |
| Building Associate | NS | NS | NS | NS | NS | NS | NS | S | NS |
Source · Jobs and Skills Australia 2025 Occupation Shortage List, six-digit download. Project Builder (shortage in WA and NT only) and Building Associate (shortage in NT only) are the two occupations in this selection that are not nationally short.
Section 04 · Build times
How labour shortages affect building times
When qualified tradespeople are hard to find, projects stall between stages, waiting for a framer, a plumber, an electrician, or a tiler to become available. Those delays compound across the build sequence.

Average house build times have eased to 2.80 quarters in 2025-26, down from the pandemic peak of 3.47 in 2023-2413, but still more than half a quarter (about two months) longer than before the pandemic. Apartment build times moved in the opposite direction, reaching a record 9.54 quarters in 2025-26.

Section 05 · Building costs
How labour shortages affect building costs
House construction input costs are 42% above their 2019 level, with the input price index at 167.8 in June 202614. Annual cost growth has eased sharply from a peak of 17.3% in mid-2022, although it picked up to 3.8% by June 2026 on higher material, freight and fuel costs, and the industry is operating on a structurally higher cost base than before the pandemic.
- Current index level
- 167.8
- House construction input price index, June 2026
- Year-on-year change
- +3.8%
- Annual growth rate, June quarter 2026, picking up on material, freight and fuel costs
- Above 2019 average
- +42%
- Current index vs 2019 annual average; cost base is structurally higher
- Peak annual growth
- +17.3%
- June quarter 2022, the sharpest annual increase in the series
Annual growth in input prices peaked at 17.3% in the June quarter 2022 and had eased to 2.5% by March 2026, before edging back up to 3.8% in June 2026 as material, freight and fuel costs rose. With the index at 167.8, input costs are now 42% above their 2019 level.
Labour shortages were one contributor to this increase, alongside materials costs, supply chain disruption, energy costs, and elevated demand. A persistent inability to staff projects at scale added to the pressure during the peak period.
Section 06 · Housing targets
Can Australia build 1.2 million homes with the workers it has?
Australia commenced 52,166 dwellings in the June quarter 202615, equal to 86.9% of the 60,000-per-quarter pace required to hit the 1.2 million homes target by June 2029.
At the current rate, the five-year total would reach roughly 1.04 million homes, about 160,000 short of the target. Building approvals of 16,953 in August 202616 suggest the pipeline is not yet accelerating fast enough to close that gap.
Infrastructure Australia estimates the infrastructure workforce was already short about 141,000 workers in October 2025, and projects that shortfall could peak at 300,000 workers in 202712. Housing draws on many of the same trades, so that gap adds to the pressure on residential building.
- Target: dwellings per quarter
- 60,000
- National Housing Accord, 1.2 million homes by June 2029
- Actual: June quarter 2026
- 52,166
- 86.9% of target pace — ABS Building Activity, June quarter 2026 (original)
- Approvals annualised
- approx. 203,400
- 84.8% of target pace — 16,953 approvals in August 2026 × 12 months
Section 07 · Apprenticeships
Construction apprenticeships: growth, gaps, and the pipeline ahead
Apprenticeship numbers are still shrinking overall, with 289,090 active apprentices and trainees recorded at 31 March 2026, down 9.0% on a year earlier17, but trade commencements have begun to turn up. Growth in the March quarter 2026 was led by electrician starts, up 19.0%, and carpenter and joiner starts, up 10.3%, on the same quarter of 2025. But completions lag starts by three to four years, meaning today's new entrants will not ease today's shortage until 2029-30 at the earliest.
In the 12 months to March 2026, trade commencements fell 1.1% to 77,550, the fourth consecutive annual decline, while trade completions rose 9.9% to 55,570, with completions for construction trades workers at a record high. The March quarter 2026 brought growth in several of the trades under the most acute pressure, compared with the same quarter of 2025:

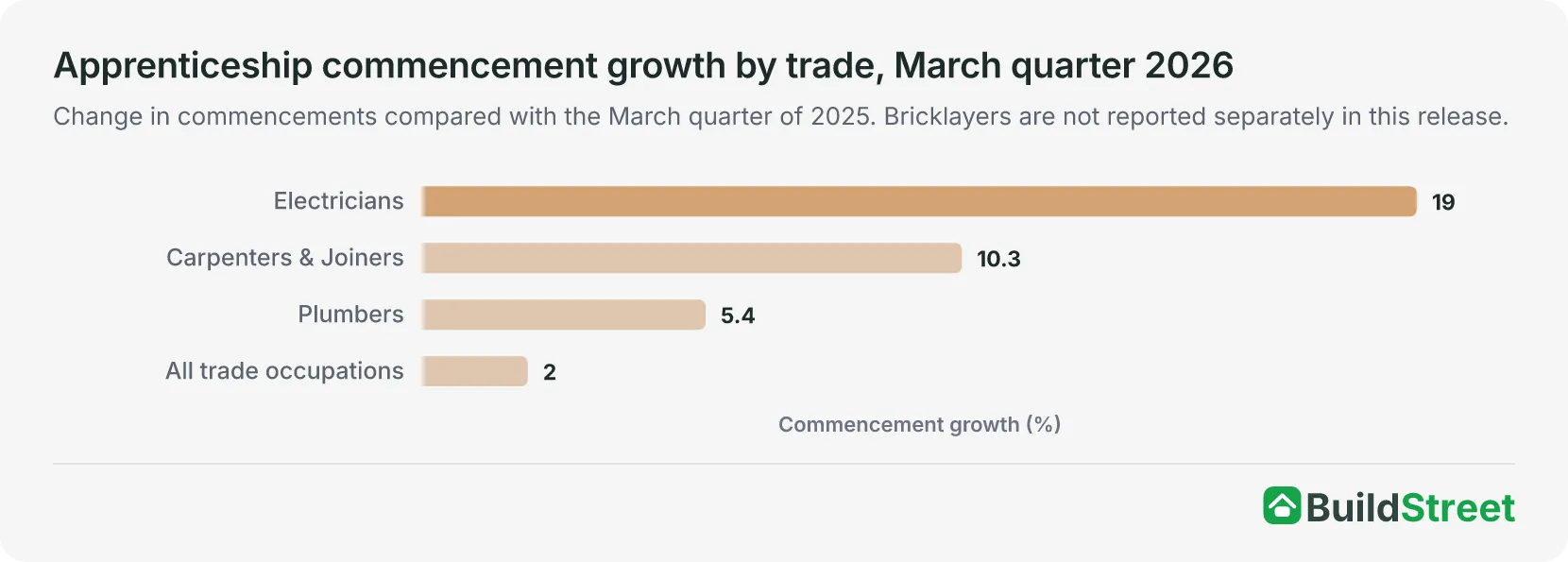

- +19.0% Electrician commencements, a record high for the quarter
- +10.3% Carpenter and joiner commencements
- +5.4% Plumber commencements
- +2.0% Trade commencements overall
These increases follow several years of decline. Completions are what actually relieve the shortage, and completions lag starts by three to four years.

Section 08 · Migration
Can skilled migration fill construction trade gaps?
Employer-sponsored visa pathways give construction businesses a route to recruit experienced workers from overseas when domestic candidates are unavailable.
In 2024-25, 5,510 primary visa grants were made to construction industry sponsors, a 30.9% increase from 4,210 in 2023-2418.
Migration is helping at the margin, particularly for experienced and specialised roles, but the scale is modest against a workforce of 1.39 million1 and a projected infrastructure workforce shortfall of up to 300,000 by 202712.
Key trades, including Carpenter, Carpenter and Joiner, Electrician (General), and Plumber (General), are on the skilled occupation list for employer-sponsored pathways, including the 482 and 186 visas. Migration can fill specific gaps where domestic pipelines are slowest to respond. It supplements domestic training and retention efforts; it cannot replace either at current volumes.
Section 09 · Solutions
What can help reduce construction labour shortages?
No single policy closes the gap across the whole sector because the shortage has three main causes. Effective responses differ by trade type, with plumbing and carpentry needing more completions, electrical and management roles needing better training-to-work pathways, and bricklaying, plastering and tiling needing improved working conditions.
For education-and-training-gap trades: lift completions, not just starts
For plumbing and carpentry, more apprenticeship commencements are necessary but not sufficient. What relieves the shortage is qualified workers completing their training and staying in the industry. Employer capacity to supervise and train, apprentice support programs, and training-to-employment transitions are the key levers.
For suitability-gap trades: improve experience pathways
For electricians and construction managers, the gap between training outcomes and what employers actually need is the problem. That requires stronger training-to-work transitions, more structured site experience, better pre-qualification assessment, and clearer alignment between what training delivers and what the industry requires.
For retention-gap trades: make the work sustainable
For bricklayers, plasterers and tilers, attracting more entrants will not fix the problem if the conditions that drove previous workers out remain unchanged. Retention shortages are linked to pay, working conditions, culture, and access barriers. More stable pipelines of work, safer and better-managed sites, and more consistent employment are the relevant remedies.
Better coordination between housing and infrastructure pipelines could reduce direct competition for the same workers. Reform of the National Construction Code and greater use of modern construction methods could reduce pressure on scarce trades more broadly. Housing and major public infrastructure are in direct competition for the same workers through to at least 2029.
Section 10 · Buyer impacts
What construction labour shortages mean for homebuyers
With input costs still 42% above 2019 levels and average house build times almost 30% longer than before the pandemic, labour shortages now have direct practical effects on anyone building or buying a new home, from longer wait times and higher costs to greater contract and financing risk.
See what it costs to build a house in Australia and how long it takes for current data on build costs and timeframes.
Builds may take longer
When trades are hard to schedule, projects stall between stages. Average house times are still more than half a quarter longer than before the pandemic.
Labour costs are elevated
Input costs are 42% above their 2019 level. Quotes may carry higher labour and subcontractor rates than a few years ago, particularly for electrical, plumbing, and finishing trades.
Fixed-price contracts carry more risk
In a tight labour market, builders may have less flexibility to absorb cost overruns in fixed-price contracts. Some have included rise-and-fall clauses or price review mechanisms.
Delays affect loan timing and planning
Construction loans often have staged drawdown schedules tied to build milestones. Delays can affect interest periods, rental overlap costs, and moving plans if the handover timeline shifts significantly.
Apartments are affected differently

Apartment build times hit 9.54 quarters in 2025-26, a record, and have not yet started to ease. Buyers in the off-the-plan market face more timeline uncertainty than buyers of detached houses.
Builder relationships affect scheduling
A builder's relationships with subcontractors can affect scheduling reliability, including site access and build pace when trades are scarce.
