Updated
House construction prices in Australia surged 40.8% between September 2020 and June 20241, according to ABS producer price data for house construction. That increase reset the cost baseline. By June 2026 the index stood 49.7% above its September 2020 level and was rising at 5.9% a year, the fastest annual pace since June 20232. On the consumer side, ABS CPI new dwelling prices were up 5.7% in the year to July 20263.
The double-digit increases of 2021 and 2022 have since eased, but they've stacked onto a cost base that was already at a historic high. The index remains well above its pre-pandemic level. The sections below set out which cost pressures have eased, which have persisted and where further pressure may come from.
- House construction PPI surge (Sep 20 – Jun 24)
- +40.8%
- Fastest residential escalation on ABS record
- Current annual rate (Jul 2026)
- +5.7%
- ABS CPI new dwelling prices, 12 months to July 2026
- Construction insolvencies (FY26)
- 3,472
- Sector ranked #1 for insolvencies again · ASIC Series 1
Australian building material costs: how much prices have increased since 2020Building material costs in Australia are 41.2% higher than in early 2020, even though annual price growth has slowed sharply. ABS data shows annual inflation peaked at 17.3% in mid-2022 and eased to…
How many homes are built in Australia each year?Australia built 169,059 new private sector homes in 2025, or about 172,642 when public and community housing is included. That was down from 175,166 in 2024 and remains well below the pace needed to…Section 01 · The Cost Reset
Why have construction costs in Australia risen so sharply after 2020?
Australia's homebuilding cost base did not just rise after 2020. It reset. What had been a relatively steady pattern of price growth gave way to a sharp and sustained escalation, driven by stimulus-fuelled demand, supply chain disruption, labour shortages and higher risk pricing across the sector. The ABS Producer Price Index for house construction tracks the prices building businesses receive for their work, capturing not only materials but also labour, contractor margins and risk pricing. Between 2006 and 2019, the index rose at a relatively steady pace of about 2.7% a year. From 2020, that stability broke down. Six consecutive quarters of double-digit annual growth between December 2021 and March 2023, peaking at 20.5% in September 20221, pushed costs higher at an extraordinary pace. By June 2026, the index had reached 182.6, a 47.0% increase from 124.2 in December 2020, and it was rising at 5.9% a year again, the fastest annual pace since June 2023.
Why construction costs surged after 2020
The HomeBuilder stimulus launched in 2020 and pushed a surge of consumer spending into the residential sector just as global supply chains were breaking down. Structural timber prices rose almost 60% between December 2020 and their September 2022 peak4. Steel followed. Freight rates hit records. Builders who had signed fixed-price contracts before the surge lost much or all of their margins. Construction became the top sector for corporate insolvencies, a position it has held since 2022.
Copper prices are rising and adding pressure
With timber prices stabilising, the next major input shock for the construction industry is copper. Prices reached around US$14,800 per tonne in September 2026, a rise of roughly 47% year-on-year5. The rise reflects structural demand from global electrification, renewable energy grids and AI data centres rather than a temporary supply chain problem. Industry forecasters expect at least two more price rises in electrical cabling before the end of 2026.

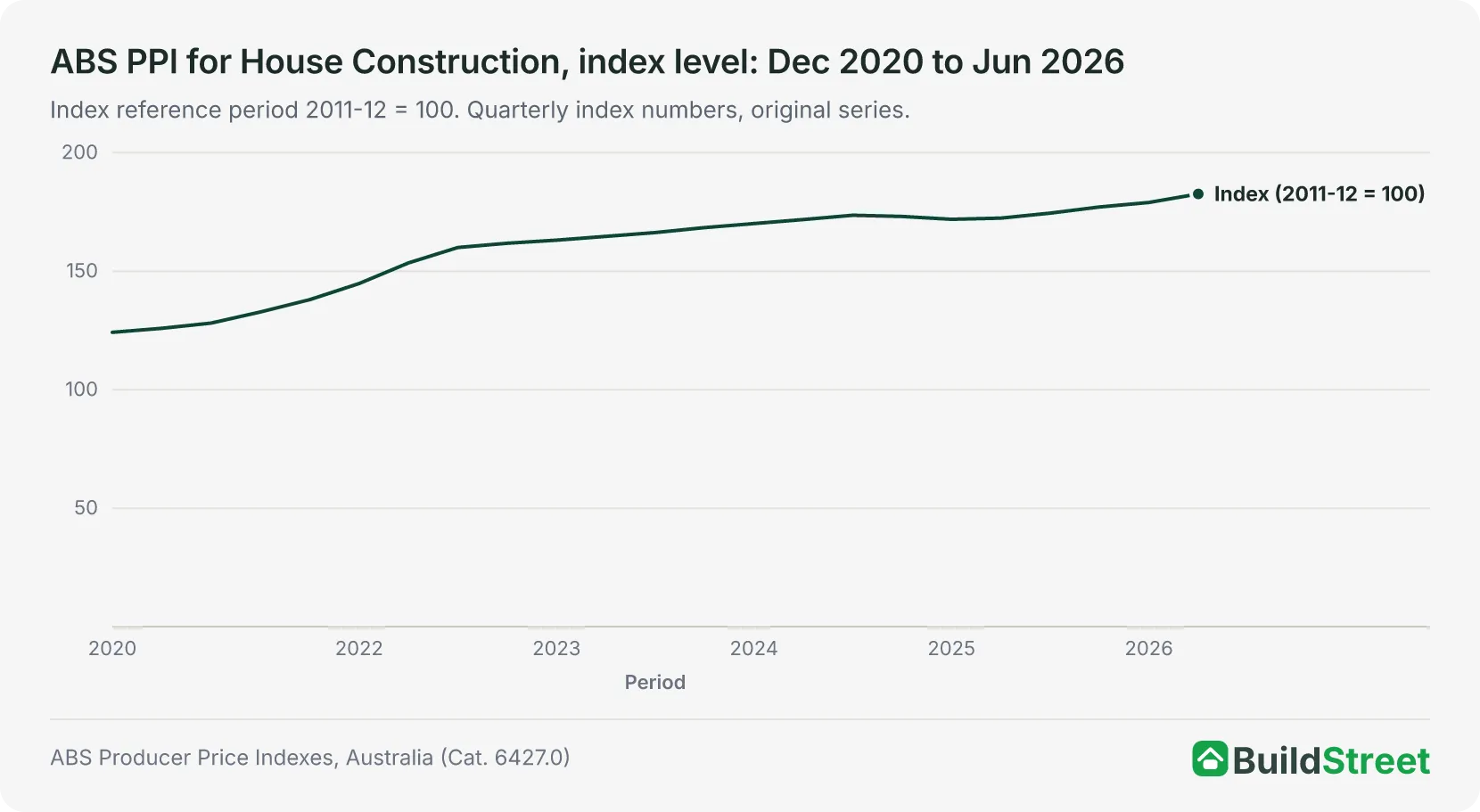

Dec 2020
124.2 · +2.9%
Pandemic onset. Temporary deflation fears gave way to massive fiscal stimulus. The HomeBuilder program launched, flooding demand into the sector.
Dec 2021
138.0 · +11.1%
Early supply shock. Global shipping constraints and initial material shortages started pushing input costs well above pre-pandemic norms.
Sep 2022
Peak160.0 · +20.5%
Hyper-escalation. Timber and steel prices hit records. Labour mobility collapsed as trades were locked into backlogs across multiple states simultaneously.
Dec 2022
161.8 · +17.2%
Persistent inflation. Despite some supply chain easing, elevated costs entrenched themselves across the industry. Builder insolvencies began accelerating.
Jun 2023
164.7 · +7.3%
Disinflation phase. The growth rate began slowing, but was still compounding onto a base that had already surged more than 20% in two years.
Dec 2023
168.4 · +4.1%
Stabilisation. Builders absorbed costs through renegotiation. Domestic labour shortages replaced material price shocks as the primary pressure.
Jun 2024
171.8 · +4.3%
Secondary rebound. Public infrastructure projects began competing heavily with residential builders for concrete, steel and skilled labour.
Dec 2025
177.1 · +2.3%
Post-peak plateau. Growth slowed, but from a cost base that is now 42.6% above where it was in late 2020. The new normal is structurally more expensive.
Jun 2026
182.6 · +5.9%
Re-acceleration. House construction prices rose 2.0% in the June quarter, the largest increase since September 2022, as higher fuel and freight costs pushed annual growth to its fastest pace since mid-2023.
Source · ABS Producer Price Indexes, Australia, June 2026 (Cat. 6427.0), Table 17, house construction (3011); ABS Consumer Price Index, Australia (July 2026).
Section 02 · Sector Spend

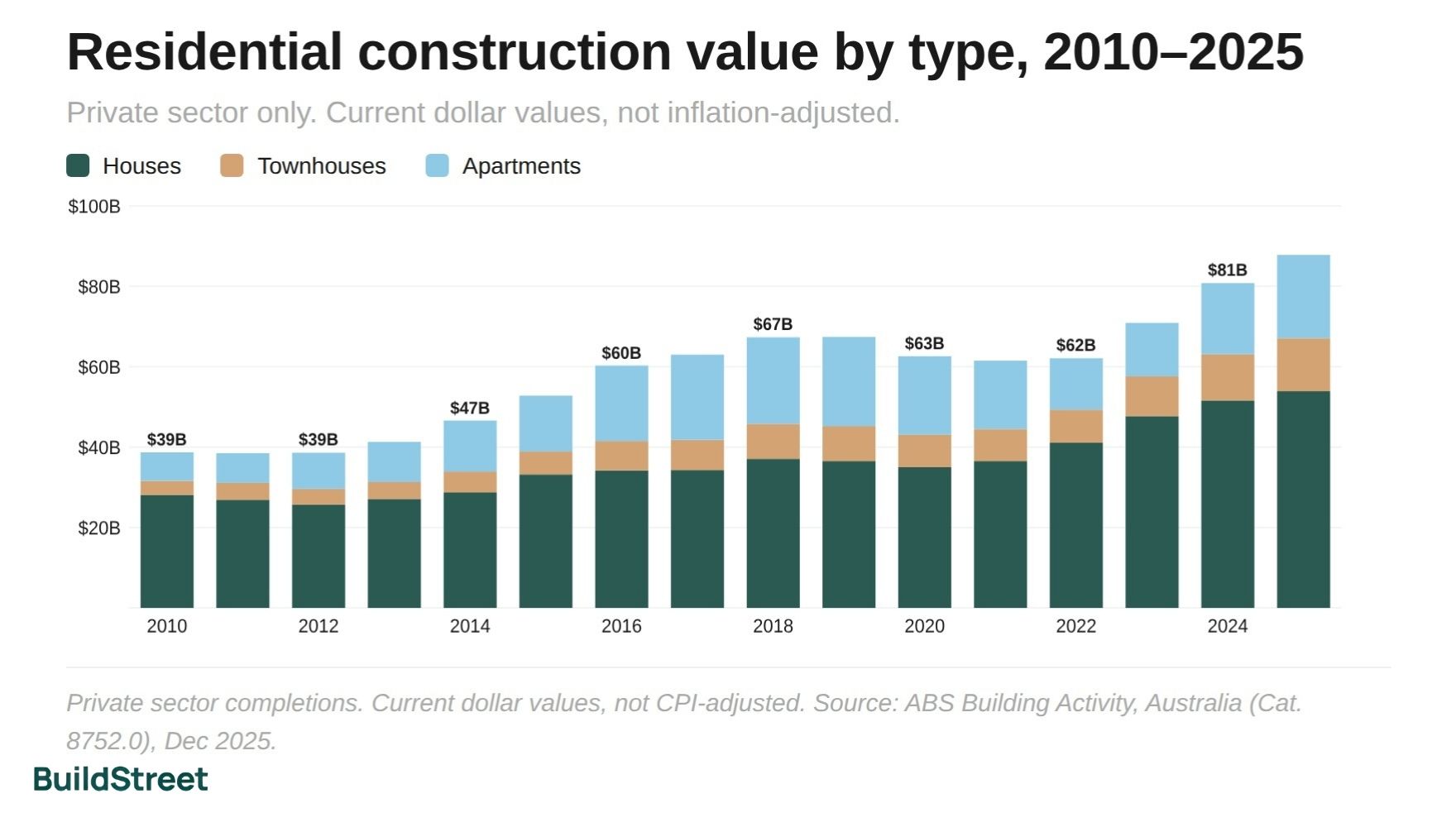

Residential construction spending since 2020: higher costs, not more homes

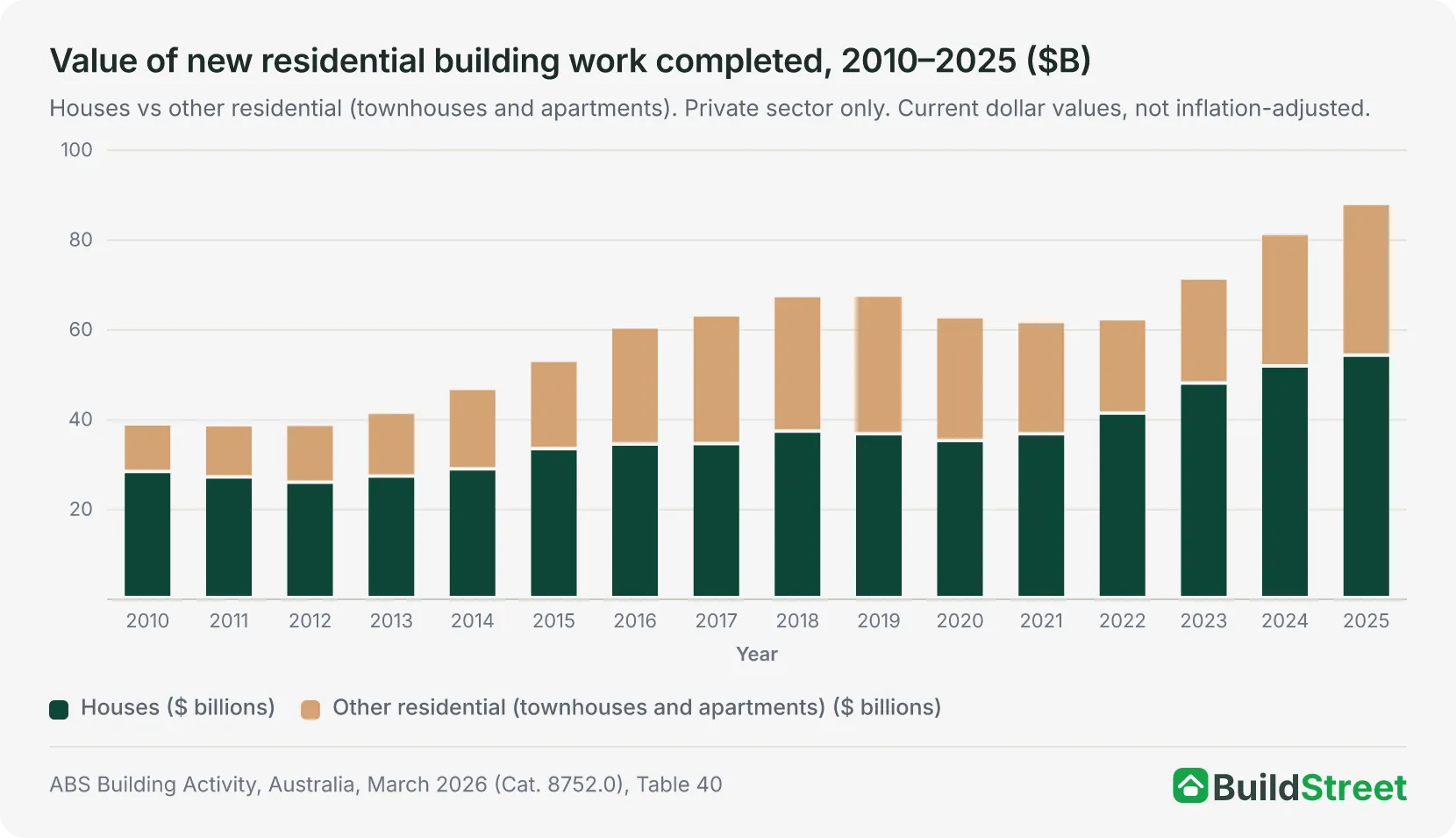

Australia spent more on residential construction in 2025 than at any point in recent years, but the increase says more about cost inflation than a building boom. The nominal value of new private-sector residential construction completed reached $87.8 billion, up 40.3% from $62.6 billion in 20206. While that points to strong growth on paper, the underlying mix shows how much of the increase has come from higher costs rather than more homes being delivered. House construction remained the dominant segment at $54.0 billion, up 54% from 2020, despite detached housing completions shifting only marginally over the period. That makes the $19.0 billion increase overwhelmingly a cost story. Other residential building (townhouses and apartments together) is in a different cycle. Its completed value fell to a $21.0 billion trough in 2022 as the apartment pipeline emptied, and has since climbed to $33.8 billion in 2025, up 23% on 2020 and finally above its 2019 peak of $30.9 billion.

Section 03 · National Averages

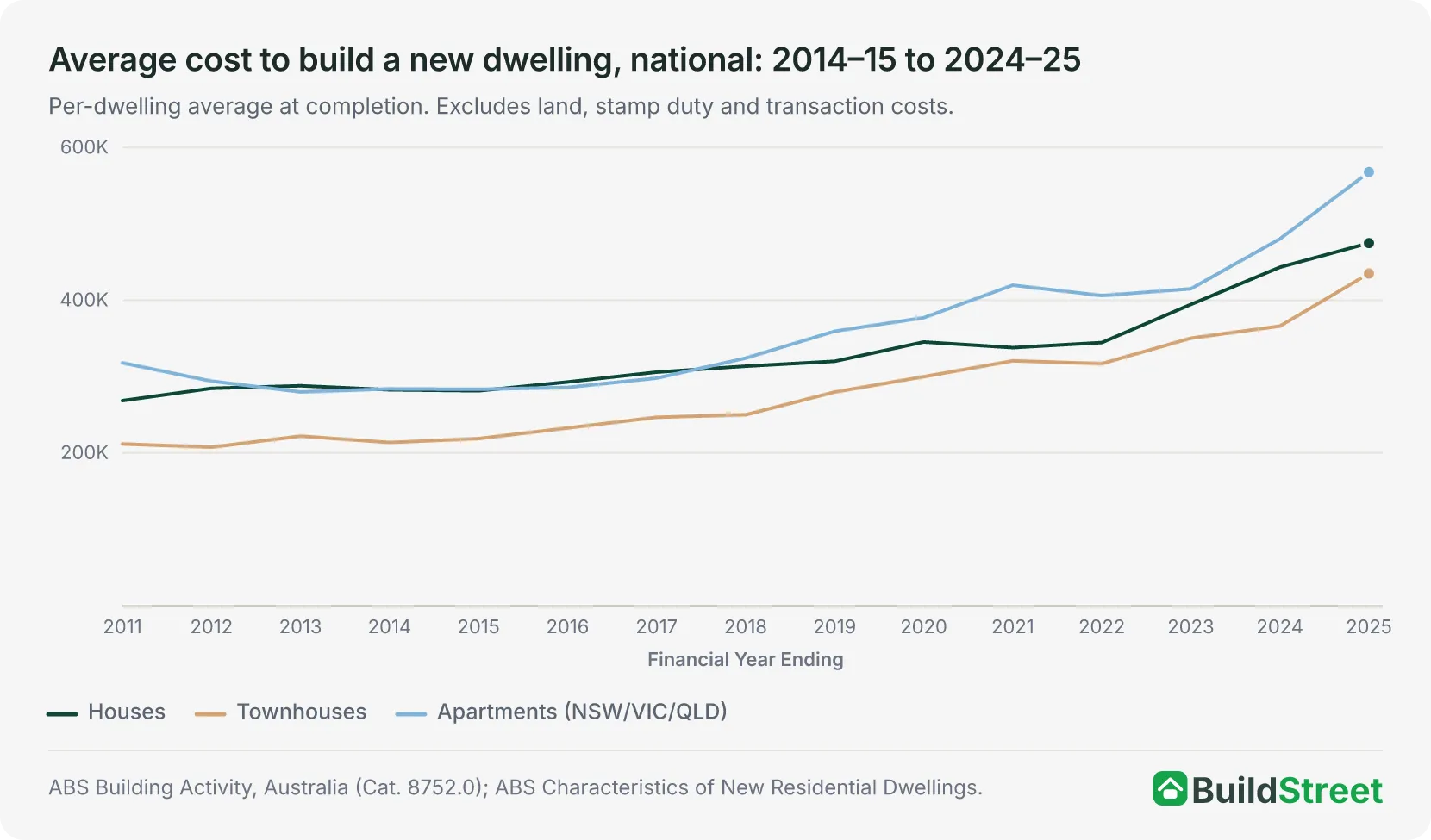

Average cost to build a new home in Australia since 2020–21
The nominal dollar value of construction tells one story, and the average cost of building an individual home tells another. Since 2020–21, the national average cost to build a new house has risen from $338,051 to $474,939 in 2024–257. Townhouses and apartments have followed a similar pattern. Average floor areas have not fallen enough to offset those cost increases. The average new house is slightly larger than it was in 2020–21, meaning Australians are paying more per square metre for roughly the same amount of space.

House · National
$474,939
- Avg floor area (2024–25)
241.5 m²
- Cost per m²
~$1,967/m²
- Floor area in 2020–21
230 m²
- Cost per m² in 2020–21
~$1,470/m²
- Cost per m² change
+$497/m² (+34%)
Townhouse · National
$435,089
- Avg floor area (2024–25)
174.5 m²
- Cost per m²
~$2,493/m²
- Floor area in 2020–21
166.4 m²
- Cost per m² in 2020–21
~$1,928/m²
- Cost per m² change
+$565/m² (+29%)
Apartment · NSW/VIC/QLD
$567,947
- Avg floor area (2024–25)
125.3 m²8
- Cost per m²
~$4,533/m²
- Floor area in 2020–21
116.1 m²
- Cost per m² in 2020–21
~$3,616/m²
- Cost per m² change
+$917/m² (+25%)
Cost per m² is derived by dividing average build cost by average floor area for each financial year. Apartment floor area includes common areas and hallways divided across all dwellings in a building, which tends to inflate the per-m² figure relative to houses and townhouses.
Section 04 · City Outlook
Construction cost growth by city: Brisbane leads while Sydney eases
Construction cost pressures are no longer moving in lockstep across Australia. A clear two-speed market is emerging, with Brisbane and parts of Queensland accelerating sharply while Sydney and Melbourne experience a more moderate pace of escalation. Tender Price Index data, which captures what contractors actually charge for a job, including margins and risk premiums as well as material costs, points to a widening gap between the major east coast markets. At the heart of that divergence is infrastructure demand. In Queensland, large-scale projects are drawing trades and materials away from residential work, intensifying cost pressures in the housing sector.
| City | 2025 TPI growth | 2026 TPI forecast | What's driving it |
|---|---|---|---|
| Brisbane | 5.0% | 7.0–7.5% | 2032 Olympics prep, $3.8B stadium and statewide energy rollout absorbing all available trades capacity. |
| Gold Coast | 4.5% | 6.0% | Olympics pipeline rapidly consuming skilled tradespeople across South East Queensland. |
| Townsville | 6.0% | 6.0% | Sustained defence and infrastructure demand creating extreme capacity constraints, with no easing expected. |
| Perth | 5.4% | 5.3–5.5% | Nation-leading population growth and Australia's most active detached housing market keeping pressure steady. |
| Adelaide | 3.5% | 5.1% | Major healthcare and defence projects entering peak construction, draining residential labour supply. |
| Darwin | 5.0% | 5.2% | Limited Tier 1 contractor competition and sustained federal defence infrastructure spending. |
| Canberra | 3.75% | 4.5% | Hospital and security precinct early works pulling trades away from the residential sector. |
| Melbourne | 4.0% | 4.0% | High baseline with builder insolvencies reducing some demand, but thinning competition at the same time. |
| Sydney | 4.5% | 4.0–4.5% | Temporary subcontractor availability improvement; affordability ceiling dampening new build demand. |
Source · RLB Australia Market Intelligence Update Q1 2026; Altus Group, Australian Construction Price Outlook Q4 2025. TPI measures contractor pricing including margin and risk loading, making it a more forward-looking indicator than materials price indices alone. Forecasts reflect committed infrastructure pipelines and should be read as indicative ranges.
Sydney's slower forecast reflects weaker demand rather than easing cost pressure. Construction prices have risen to a level that is suppressing demand, and builders are holding quotes down to win work. The improvement in subcontractor availability may be temporary: major high-density projects and the Western Harbour Tunnel are due to move into active construction later in 2026, which would increase competition for trades.
Section 05 · What's Eased
Which construction costs have eased since the 2022 peak
Not every cost input has kept rising. Some of the most acute pressures from 2021 and 2022 have eased, giving builders and buyers partial relief:
- Global shipping. The worst of the pandemic disruption (container shortages, port backlogs and erratic international freight) has passed. Water freight prices fell 8.3% in the year to June 20262 as pandemic-era increases continued to unwind, although emergency fuel surcharges linked to the Middle East conflict lifted them 15.5% in the June quarter 2026.
- Structural timber. Timber, which forms the core of most Australian residential builds, has been broadly stable in price since mid-2024. The ABS structural timber index was 169.4 in June 2026, 11% below its September 2022 peak but 4.1% higher than a year earlier4.
Section 06 · Lingering Pressures
Which building costs are still rising in 2026
The easing in timber and shipping has been partly offset by a different set of pressures, many of them structural rather than cyclical and unlikely to reverse quickly.
- Copper price
- US$14,800/t
- +47% year-on-year (September 2026).
- Electrical wiring, plumbing and HVAC all affected. At least two further cabling price rises expected in 2026.
- Labour wage target
- +4% p.a.
- Minimum union target across 2026 enterprise agreements.
- Trade shortages mean these targets are largely achievable across all states.
- Construction insolvencies
- 24.5% share
- 3,472 of the 14,153 FY26 insolvencies. Down 3% year-on-year after a 21% jump in FY25.
- Surviving builders price in sharply higher risk margins when competitors collapse.
Copper is especially disruptive because it tends to hit late in the build, when projects have the least flexibility to absorb additional costs. Because it sits at the centre of global electrification, renewable energy expansion and AI data centre construction, the pressure on copper prices appears structural rather than temporary. Labour conditions are similarly tight. With state governments simultaneously pushing ahead with hospitals, highways and housing, the conditions for wage pressure to ease are still not in place.
Fuel and road freight have also turned from relief to pressure. The closure of the Strait of Hormuz pushed fuel prices sharply higher in the June quarter 2026, and road freight prices rose 15.5% in the quarter, the largest rise since the series began in 19972. Many builders passed the higher fuel and delivery costs on to customers.
Section 07 · Cost of Money
How interest rates have changed the cost of building since 2020
Rising construction costs aren't the only burden on borrowers. The past five years have also brought the sharpest monetary policy tightening in over a decade, and for anyone borrowing to build, the monthly cost of carrying the debt has surged separately from what it costs to construct the home.
April 2020 · Pandemic baseline
- Typical variable rate
2.8–3.4%
- Monthly repayment ($730k, 25 yrs)
~$3,460
- Avg NSW loan size
lower baseline
- QLD loan size growth (1 yr)
—
August 2026 · Current
- Typical variable rate
6.0–6.5%
- Monthly repayment ($730k, 25 yrs)
$4,700–$4,930
- Avg NSW loan size (2026)
$872,752
- QLD loan size growth (1 yr)
+16% (~$100k)
Monthly repayment estimates use principal and interest on a 25-year term. Actual repayments will vary by lender and loan structure. Source: RBA Statement on Monetary Policy, August 2026; RBA Statistical Table F6, housing lending rates to July 2026.
Higher construction costs and higher interest rates are compounding each other. A buyer who needed to borrow $730,000 in 2020 is now, in many cases, borrowing considerably more because the build itself costs more, while also servicing that larger debt at a rate roughly 330 basis points higher9. That monthly gap of about $1,35010 is calculated on the same $730,000 loan, so the gap is larger for borrowers whose loan has grown with build costs.
Section 08 · Adapting
How modular construction and smaller homes are reducing building costs in 2026
Faced with unpredictable labour availability, material cost spikes, long delays and expensive finance, the Australian market is adapting. Two approaches are gaining traction among cost-conscious buyers and developers.
Smaller, high-performance footprints. The old ambition of maximising floor area is giving way to the economics of 2026. Fewer square metres means fewer expensive trades, less material and a smaller exposure to cost blowouts. Passive house systems, which once added 15–20% to build cost, now typically add around 5–10% as local expertise and supply chains have caught up. That narrows the cost premium for higher-performance homes.
Modular and prefabricated construction. The Australian prefab market has grown by over 20% annually in recent years. Modules are built in climate-controlled factories while on-site preparation happens in parallel, cutting total timelines by 30–60%. The main benefit is cost certainty in a market where variation risk has become the norm.
Modular / Prefabricated
- Cost certainty
High cost certainty (fixed-price standard)
- Weather delays
Minimal weather delays (built indoors)
- Build time
30–60% faster than traditional
- Structure
Welded steel chassis, often termite-proof
- Site impact
Low site impact (crane install, low waste)
- Indicative cost
~$380,000 fixed (150 m² 3BR example)
Traditional site-built
- Cost certainty
Low (prime cost and provisional sum exposure)
- Weather delays
Frequent stoppages
- Build time
12–24 months typical
- Structure
Timber or block frame, standard
- Site impact
Extended noise, waste and disruption
- Indicative cost
$400,000–$450,000+ variable
Cost estimates are indicative ranges and will vary significantly by location, specification and contractor. Source: S2A Modular, Modular vs Traditional Construction in 2026.
For traditional builds, industry professionals commonly cite a 10–15% cash contingency buffer, held in cash rather than borrowed, to cover the cost variations that remain common in a structurally inflated market. With construction costs forecast to rise a further 4.0–7.5% through 2026, depending on the city, project delays add directly to final costs.
